Flexible Pharmaceutical Facility Design: Planning for Capacity Changes, New Modalities and Future Expansion

Flexible Pharmaceutical Facility Design

A pharmaceutical plant rarely remains exactly aligned with the assumptions made at concept design. Pipelines shift, volumes change, and a new modality can arrive with different containment, utility, and storage needs. Plants that cannot absorb those changes face costly retrofits while production waits.

This guide covers flexible pharmaceutical facility design from concept to expansion: layouts, expansion zones, spare utility capacity, HVAC zoning, multiproduct controls, equipment choices, and new modalities. One point first. No facility is flexible everywhere. The real job is deciding which elements to fix now and which to leave open. Here is how to decide.

Flexible Does Not Mean Free of Limits

Even in a flexible facility, some elements remain relatively fixed, such as structural constraints, primary HVAC infrastructure, electrical capacity, and main utility distribution. The goal is a facility that can change direction, change use, or expand without needless infrastructure changes or interruptions to ongoing operations.

That definition gives you a working rule. Define the backbone early and provide planned space, capacity, and interfaces for growth. Keep everything attached to the backbone easy to change.

ElementDecide early and build for growthKeep easy to change
BuildingStructural grid, floor loading, ceiling heights, expansion directionRoom partitions, door positions
HVACPlant space, main duct trunks, risers, zoning logicTerminal components and room-level controls, subject to the required change control and requalification
Clean utilitiesMain headers, plant room space, staged generationBranch lines, drops, utility panels
ElectricalIncoming supply, switchgear space, backup powerRoom distribution, equipment outlets
ProcessSuite size and grade strategyEquipment, skids, single-use assemblies
ControlsNetwork backbone and data structureRecipes, equipment configuration

Concept Design Decisions That Keep Options Open

Most flexibility is won or lost at concept design. After that, each change costs more. Teams need to think far enough ahead and test whether the available footprint can accommodate future expansion. Expanding inside the existing footprint may be preferable where feasible, which makes ceiling height and service-space planning important early. Clear heights should be established from equipment envelopes, HVAC validation and utility distribution, maintenance access, equipment movement, and defined future requirements.

Settle these items during concept design:

  1. Expansion direction: pick which side of the building or site grows, and keep it clear.
  2. Structural grid and floor loads: choose bays that suit several room sizes and heavy equipment.
  3. Ceiling height and service space: leave room for ducts, piping, and later additions.
  4. Utility routes: reserve corridors, risers, and plant room space for future growth.
  5. Flow strategy: fix the people, material, and waste paths so new suites plug into them.
  6. Grade strategy: identify where future room-use or classification changes may be feasible, and which areas should remain fixed.
  7. Hazard classification: check whether future solvents or flammable materials could change room ratings.
  8. Storage: plan cold, frozen, and cryogenic storage for products you do not make yet.
  9. Power and backup: plan incoming supply and backup power against defined future load scenarios.
  10. Capacity scenarios: write down base, growth, and new-modality cases in the design basis.

This list also drives pharmaceutical facility expansion planning later. A site that records its assumptions can test each future project against them.

Modular and Flexible Layouts

Several layout ideas help a flexible pharma manufacturing facility change without a rebuild.

  • Matrix of multi-use rooms: A flexible layout can use a matrix of multi-functional operating rooms designed to support different processes and operating scales without major changes to the overall layout. The rooms can run different processes at different scales without changing the layout. A utility floor above the operating core carries HVAC, utility access such as water for injection and air, and closed stainless-steel connections between areas.
  • Modular and podular construction: Panel-based modular construction prefabricates cleanroom panels and frames offsite for assembly on site. Podular construction builds a working cleanroom with its HVAC offsite and delivers it as a module. Modular designs can also support staged investment and allow capacity to be introduced in phases as manufacturing requirements evolve.
  • Suites built one at a time: Sites can also build an initial production suite and add flexible suites as products or capacity requirements advance. Building suites in phases allows lessons from each installation to inform later expansion and gives teams an opportunity to introduce new technology into subsequent phases. A related “empty bedroom” approach relied on disposables and skid-mounted equipment so a suite could take on different work.

Pharma Access’s Modular Mobile Facility (MMF) approach extends this principle by allowing a substantial portion of facility fabrication and systems integration to take place off-site while enabling works and other site activities progress in parallel. For future expansion, the value is strongest when structural interfaces, utility tie-ins, access routes, automation architecture, and qualification requirements are considered during concept design, allowing additional modular capacity to be integrated in planned phases with controlled impact on existing operations. Modularity does not remove the need for long-term facility planning; it makes early interface planning even more important.

Pharmaceutical Facility Expansion Planning: Zones, Phasing, and Spare Capacity

Expansion Zones

Reserve space for growth on purpose. Practical options include:

  • Shell space: build the envelope and main services for a future suite and fit it out later.
  • Convertible areas: identify rooms such as atrium or warehouse space that could become process space, and check ceiling height and structure.
  • Clear adjacent land or bays: keep the growth direction free of fixed obstacles such as plant rooms and roads.
  • Removable wall sections: plan a future opening where the new area will connect.
  • Modular expansion interfaces: define planned locations where future modules or prefabricated facility sections could connect, including structural interfaces, utility tie-ins, access routes, and control-system integration.

Utility Spare Capacity

Future utility demand is generally easier to accommodate when plant space, distribution routes, and connection provisions are considered during initial design rather than retrofitted after the facility becomes operational. Core HVAC, clean utility, and electrical infrastructure are not flexible in the same way as process equipment, so future load scenarios should be considered early.

Treat spare capacity in layers:

  • Space and routes first: reserve plant room floor area, risers, and corridors.
  • Distribution next: size main headers, trunks, and switchgear against documented growth scenarios where justified, with planned connection points suitable for future expansion.
  • Generation last: add chillers, boilers, water generation, and similar plants in stages as load arrives.

Choose the spare allowance from your scenarios, not from a rule of thumb. Write the number and its reasoning into the design basis.

Future Utility Loads to Model

  • Purified water, water for injection, and clean steam
  • Chilled water, hot water, and HVAC heat rejection
  • Electrical load and emergency power
  • Compressed air, nitrogen, and other process gases
  • Ultra-low temperature and cryogenic storage
  • Effluent and waste streams

Ultra-low-temperature freezer installations can add significant HVAC load to their rooms while also increasing electrical and heat-rejection demand. A plant that has not modelled those loads can discover the constraint only after additional equipment or storage capacity is introduced.

HVAC Zoning That Survives Change

HVAC Zoning That Survives Change

HVAC drives many of the limits on a flexible design, so zone it with change in mind. Pharma Access lists HVAC system design, mechanical and utility system design, and modular clean room design among its disciplines, which shows how closely these topics sit together.

Use these design moves:

  • Zone by function and product: Define HVAC zoning according to cleanliness classification, process risk, containment requirements, and the contamination-control strategy. Dedicated or appropriately segregated air-handling should be provided where required by the process and risk assessment.
  • Allow independent control: Where appropriate, allow individual zones to shut down, set back, or be controlled without unnecessary impact on adjacent areas.
  • Reserve ductwork space: Leave risers, ceiling room, and plant space for added air handlers.
  • Design pressure relationships with future use in mind: Future room-use changes may require changes to pressure relationships, but these should be managed through risk assessment, change control, and appropriate requalification.
  • Plan filtration and airflow carefully: Filtration, airflow patterns, room pressure relationships, and air-system segregation are important elements of the contamination-control strategy and should be evaluated against the process risk.

Multiproduct Pharma Facility Design: Controlling Cross-Contamination

A multiproduct pharma facility design must keep one product away from the next. EU GMP expectations require cross-contamination risks to be controlled through appropriate technical and organisational measures, supported by Quality Risk Management and toxicological evaluation where applicable. Dedicated or segregated manufacturing areas may be required where the identified risks cannot be adequately controlled through shared arrangements.

Risk-based shared-facility approaches use Quality Risk Management principles and health-based exposure limits, including PDE or other scientifically justified exposure values, to support decisions on the controls required in shared manufacturing environments. For multi-modality facilities, segregation of operating areas may also form part of the overall contamination-control strategy.

Design tools that help include:

  • Separate or segregated suites, gowning areas, and airlocks were justified by product, biosafety, containment, or cross-contamination risk.
  • One-way flow for people, materials, and waste.
  • Closed processing and single-use assemblies, which cut open handling and cleaning burden.
  • Dedicated or segregated HVAC for higher-risk products.
  • Material and equipment transfer routes that do not cross clean paths.

For autologous cell therapy, the logistics risk grows. Patient-specific manufacturing requires robust chain-of-identity and chain-of-custody controls alongside the facility’s contamination-control and material-flow strategy.

Equipment Flexibility

Equipment choices decide how fast a room can change over.

For multi-process layouts, key planning topics include a rationalized equipment list, ease of equipment changeover, and standardized utility interface design. Single-use technology can support faster equipment changeover and connection where interfaces are standardized, while automation design should allow new equipment to integrate with the selected facility control architecture.

Practical choices include:

  • Skid-mounted and wheeled equipment with quick connections
  • Standard utility panels and connection types across rooms
  • Single-use assemblies where changeover speed matters most
  • Stainless equipment where volume and steady demand justify it
  • A control platform that accepts new equipment and recipes without a rebuild

The single-use and stainless decision belongs here. It shapes utility load, footprint, and the cleaning validation burden, so make it with the facility plan, not after it.

Planning for New Modalities

A new modality can break assumptions that held for decades. The table summarizes typical facility considerations that should be assessed during future-capacity planning.

ModalityWhat it asks of the facility
Monoclonal antibodies and proteinsBioreactor scale, downstream space, utility load
Cell and gene therapyVector or process platform, biosafety requirements, closed processing, segregation strategy, and chain-of-identity or chain-of-custody controls where applicable
mRNA and lipid nanoparticlesProcess-specific segregation, purification requirements, closed processing, solvent and hazardous-area considerations where applicable, and temperature-controlled storage appropriate to the process and materials

Different viral-vector and cell-therapy platforms can create different biosafety, containment, segregation, culture-volume, and equipment requirements. Biosafety requirements can also change layout.

mRNA and lipid nanoparticle manufacturing can involve multiple purification operations, solvent handling, and temperature-controlled storage requirements. Cleanroom background classification should be determined from the specific process, the degree of process closure, open aseptic manipulations, and the contamination-control strategy rather than assigning one universal cleanroom grade to the modality.

Solvent use may also affect hazardous-area and electrical classification, while materials and products may require refrigerated, frozen, or cryogenic storage depending on the specific process.

So test every design against a few likely modalities. If a room cannot host a second process type with modest change, record that limit now.

Phased Expansion Without Stopping Production

Phased Expansion Without Stopping Production

Expanding next to a running plant needs its own plan.

  • Isolate construction. Separate dust, vibration, and traffic from operating areas.
  • Plan tie-ins early. Place isolation valves and capped connections where new services will join.
  • Build stand-alone phases. Each phase should run and qualify on its own.
  • Consider overlap. Design-build can start construction when design is about 60 percent complete, according to Heil, which saves time but adds risk if late design changes arrive.
  • Plan qualification with design. Commissioning and qualification for each phase should start in the concept stage.

Pharma Access lists project management, construction and installation, and CQV among its capabilities. Those phases tend to overlap in an expansion, so plan them as one program.

Next Steps: Build Flexibility Into the Plan

  1. Write capacity and modality scenarios into the design basis.
  2. Decide which backbone elements to fix and which spaces, capacities, and interfaces should support defined future growth.
  3. Reserve expansion zones, routes, and plant space.
  4. Set spare utility capacity from the scenarios and record the reasoning.
  5. Zone HVAC by function, product, and containment need.
  6. Run a cross-contamination risk assessment for the products you expect.
  7. Standardize utility panels, connections, and control platforms across rooms.
  8. Plan phased construction and qualification before the first drawing set.

Frequently Asked Questions

What is flexible pharmaceutical facility design?

It is a design approach that lets a plant change capacity, products, or technology without major rework.Designers establish the long-life engineering backbone and provide appropriate space, capacity, and interfaces for defined future scenarios while keeping selected rooms, equipment, and connections adaptable.

Which decisions belong in concept design?

Expansion direction, structural grid, ceiling heights, utility routes, flow paths, grade strategy, storage needs, and power capacity. Changing these later is costly, so record them and the growth scenarios behind them in the design basis.

How much spare utility capacity should a plant have?

No single number fits every site. Reserve appropriate space and routes, size distribution against documented growth scenarios where justified, and add generation capacity in planned stages. Set the allowance from your capacity and modality scenarios and document the reasoning.

Can one facility make different modalities?

Sometimes. Multimodal designs use separate suites, controlled flows, closed systems, and zoned HVAC. Limits remain, such as biosafety level, solvent hazards, and storage needs, so assess each modality against the design before you commit.

How does a multiproduct facility control cross-contamination?

Through risk-based design. Teams use health-based exposure limits where applicable, segregated suites, separate gowning and airlocks, one-way flows, closed processing, and well-designed HVAC. Quality risk management guides how far each control must go.

Water for Injection: Distillation vs Membrane Methods

Water for Injection: Distillation vs Membrane Methods

Water for Injection may seem like an easy thing to make. It is only water, after all. But WFI must meet stringent compendial requirements for chemical purity and bacterial endotoxins, together with tight microbiological control, because it is used in pharmaceutical applications where control of pyrogens and microbiological contamination is critical. It takes a good production system to get there, and for decades there was only one way to do it: distillation.

That is no longer the case. This guide gives plain language explanations of the methods of producing water for injection, including how distillation and membrane systems work, what changed in the regulations, and how to think through which approach fits a given facility.

What Makes WFI Different From Regular Purified Water

Systems that produce purified water reduce dissolved minerals and organic material to levels suitable for many pharmaceutical uses, but WFI must be of a higher standard. Compared with Purified Water, WFI is intended for higher-risk pharmaceutical applications and is subject to bacterial endotoxin requirements together with stringent microbiological control, in addition to applicable chemical-quality requirements.

For much of the history of the industry, distillation was the established approach for producing WFI. But that changed as membrane technology matured, and that changed the regulatory picture too.

The Regulatory Shift That Opened the Door to Membranes

Up until 2017, the European Pharmacopoeia monograph for Water for Injections required distillation as the production method. The United States and Japanese pharmacopoeias had permitted alternative purification approaches earlier, but Europe held out, with particular attention given to the microbial-control risks associated with non-distillation systems.

That changed in April 2017, when the European Pharmacopoeia revised its monograph on Water for Injections (0169) to allow production purification processes equivalent to distillation, including reverse osmosis combined with appropriate complementary techniques. This harmonised European rules with the US and Japanese pharmacopoeias, which had already accepted membrane-based approaches.

The alignment continued to widen. In 2020, membrane processes were recognised as an acceptable WFI production method in Annex 3 of WHO Technical Report Series 1025. In October 2025, the 2025 edition of the Chinese Pharmacopoeia came into force, further updating the pharmaceutical-water regulatory framework in China. Non-distillation WFI generation is now recognised across multiple major regulatory and pharmacopoeial frameworks, although applicable national requirements and product-specific regulatory commitments should always be confirmed for individual projects.USP–NF

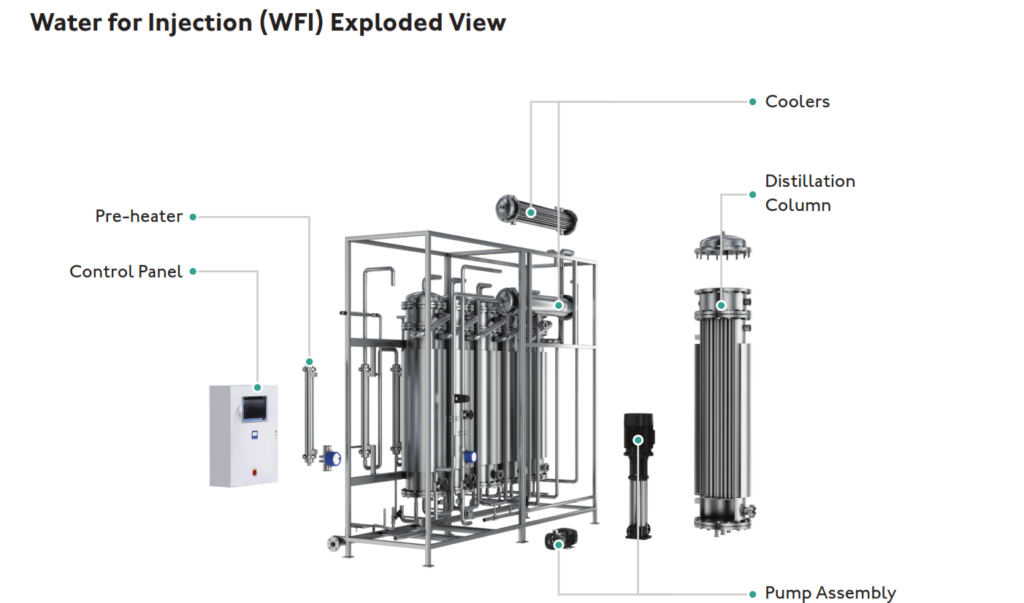

How Distillation-Based WFI Works

Distillation removes contamination by converting water into vapour while non-volatile contaminants remain in the liquid phase. Proper vapour separation and control of entrained droplets help prevent contaminants, including bacterial endotoxins, from being carried into the distillate before the purified vapour is condensed back into WFI.

Two main distillation methods dominate WFI distillation systems today.

Multiple Effect Distillation (MED)

Multiple Effect Distillation (MED)

The multiple-effect distillation WFI systems comprise a series of evaporator “effects” connected in series. Plant steam heats the first effect, and vapour generated in one effect is then used as the heating medium for the next effect, typically operating at progressively lower pressure and temperature. The heat from each effect is recycled into the next so that the total energy required is reduced as heat is reused across the system.

MED systems need separate condensers with cooling water to complete the process, and they have fewer moving parts than mechanical alternatives, which usually means lower maintenance needs. Certain MED configurations can also integrate pure-steam generation, allowing some system designs to produce both WFI and pure steam from the same unit.

Vapour Compression (VC) Distillation

Vapour compression WFI systems take a different mechanical route. VC systems reduce dependence on external steam during normal operation by using mechanical compression to increase the pressure and temperature of vapour generated in the process and then reusing the compressed vapour as the heating medium for ongoing evaporation.

This design recycles latent heat internally, generally leading to lower energy consumption for VC systems compared to MED systems, because they require less external steam and can operate with lower cooling water demands. Depending on equipment configuration, VC systems can also provide flexibility in delivering WFI at different outlet temperatures, although the final storage and distribution temperature remains a separate system-design decision.

Multiple Effect vs Vapour Compression: A Quick Comparison

FactorMultiple Effect DistillationVapour Compression
Energy sourceExternal steamMechanical compression
Heat reuseAcross sequential effectsInternal, recycled continuously
Cooling water needsHigherLower
Moving partsFewerMore
Output temperatureCooling may be required where lower-temperature WFI is neededCan offer greater outlet-temperature flexibility depending on system configuration
Typical design considerationOften attractive where reliable steam and cooling infrastructure already existOften attractive where reduced steam demand and internal heat recovery are priorities

Neither approach is universally superior. The right choice depends on what utilities are already in a facility, what output capacity is needed, and whether energy demand, lifecycle cost, operating philosophy and WFI supply temperature are priorities.

How Membrane-Based WFI Systems Work

How Membrane-Based WFI Systems Work

Membrane-based WFI production completely avoids phase change. These systems combine reverse osmosis with complementary purification technologies designed to control ionic, organic, microbial and endotoxin-related contaminants without converting water to steam and back.

The typical membrane-based WFI generation system stacks a number of stages together. The first step of purification is reverse osmosis, followed by further polishing steps such as electrodeionisation, ultrafiltration or nanofiltration. Each unit operation performs a specific purification function, and the validated combination of these stages allows the finished water to meet the applicable WFI requirements.

Membrane WFI can be generated without the high-temperature phase used in distillation and can therefore operate as a “cold” generation process, reducing the energy associated with evaporation. But this operating approach also places greater emphasis on biofilm prevention, hygienic design, membrane performance, sanitisation and microbiological monitoring. Storage, distribution and sanitisation temperatures are separate design decisions and may include hot-water sanitisation or other validated microbial-control strategies.United States Pharmacopeia

Comparing the Two Approaches

Cost

For long-term operation, the cost favours different methods depending on scale, system architecture and utility infrastructure. Membrane-based systems can reduce steam and cooling-water demand compared with multiple-effect distillation, but pretreatment, membrane stages, sanitisation strategy, membrane replacement, monitoring and redundancy must all be included when evaluating total cost of ownership. Vapour compression systems can also offer competitive lifecycle economics through internal heat recovery and lower external steam demand.

Energy Use

Membrane systems use less total energy for the generation step because they eliminate the energy-intensive evaporation process. Vapour compression is one of the distillation methods in which the latent heat is recycled mechanically rather than with a continuous supply of external steam. It uses significantly less energy from external thermal utilities than multiple-effect distillation in many system configurations.

Contamination Control

Distillation provides a strong purification barrier through phase separation, provided that the still, vapour-separation system and upstream water treatment are appropriately designed and controlled. Membrane systems are very dependent on the integrity of the membrane itself and the discipline of the sanitation schedule. A properly designed, validated and maintained membrane system can consistently produce WFI that meets applicable requirements, but particular attention must be given to biofilm prevention, sanitisation, hygienic design, membrane performance and ongoing microbiological monitoring.

Footprint and Facility Fit

Compared to a complete distillation system, membrane-based WFI systems generally require less space and can reduce infrastructure requirements in some applications, which allows facilities with limited space or phased expansion strategies to have a viable option for WFI production. Actual capital requirements depend on capacity, pretreatment, redundancy, sanitisation philosophy, automation and existing site utilities.

Read More: Cleaning Validation Limits in Pharma

Choosing the Right System for a Pharmaceutical Water System Design

A handful of practical questions that a pharmaceutical water system design decision should consider are:

  1. What utilities are available at the facility now? A site with reliable steam infrastructure may favour multiple-effect distillation, while a site that favours lower utility demand may favour vapour compression or membranes.
  2. How much floor space? Membrane systems also generally take up less physical space than a full distillation train.
  3. What volume and temperature do you want as the output? Required WFI flow rate, peak demand, turndown, storage philosophy and required supply temperature should be established before selecting the generation technology.
  4. What is the facility’s ability to monitor and sanitise? Membrane systems require a robust microbial-control strategy, and so facilities need to have staff and systems in place to manage that on an ongoing basis.
  5. How much will it cost to operate in the long term? Energy costs vary widely by region and even by facility, so it is more important to run your numbers against your actual local energy pricing rather than relying on general industry averages.

WFI Generation Is Only One Part of Pharmaceutical Water System Design

WFI Generation Is Only One Part of Pharmaceutical Water System Design

Selecting MED, vapour compression or a membrane-based system addresses only the generation stage. The complete pharmaceutical water system should be considered as an integrated chain covering feed-water quality, pretreatment, WFI generation, storage, distribution, points of use, sanitisation, monitoring and qualification.

Feed Water → Pretreatment → WFI Generation → Storage → Distribution Loop → Points of Use → Monitoring & Sanitisation

Engineering decisions around storage capacity, recirculation, hygienic piping, dead-leg control, utility loads, drainage, instrumentation, automation, redundancy and sanitisation strategy can have as much influence on long-term WFI performance as the choice of generation technology itself. These requirements should therefore be evaluated together during facility and utility design rather than as independent equipment decisions.

Getting the Water System Design Right From the Start

WFI generation should ideally be integrated into facility design from the outset. The utility loads, floor space, drainage, and water distribution loop should be designed in conjunction at the design stage, as retrofitting a distillation or membrane system into a building not designed for it usually requires costly rework.Pharma Access works with pharmaceutical manufacturers on facility and utility design that incorporates water system needs from the earliest planning stages, including layout, utility sizing and the qualification work needed to bring a WFI system into GMP-compliant operation.

A Few Final Thoughts

Indeed, the methods to produce water for injection have diversified over recent years, and the choice between distillation or membrane systems is no longer a firm regulatory requirement. Multiple-effect distillation and vapour compression each have their strengths in terms of reliability, energy consumption and output flexibility, whilst membrane-based systems have thermal-energy demand and often a smaller equipment footprint, together with greater dependence on an effective microbial-control strategy. According to the utilities, space and monitoring capacity of the facility, there isn’t one size-fits-all answer.US FDA

Frequently Asked Questions

Is membrane-based WFI now accepted everywhere, or only in some countries?

Acceptance of non-distillation WFI generation has expanded significantly. Major regulatory and pharmacopoeial frameworks now recognise validated alternatives to distillation, including membrane-based approaches. However, manufacturers should still verify the applicable national regulatory requirements, marketing-authorisation commitments and facility-specific requirements before selecting the generation technology.

Which is cheaper to operate: distillation or membrane-based WFI systems?

It is contingent upon the setup. Membrane systems can reduce steam and cooling-water demand compared with multiple-effect distillation, while vapour-compression distillation can also achieve competitive total lifecycle costs through internal heat recovery. The final comparison depends on capacity, pretreatment, utility prices, sanitisation strategy, maintenance and redundancy requirements.

Why did Europe require distillation for WFI for so long?

European regulators were concerned that non-distillation systems required robust control of microbial contamination, membrane performance and biofilm formation to ensure consistent WFI quality. These concerns contributed to the continued requirement for distillation until the European Pharmacopoeia revised the WFI monograph in 2017 to permit purification processes equivalent to distillation.

Does membrane-based WFI need more monitoring than distilled WFI?

Membrane-based WFI systems require particular attention to microbial trending, biofilm prevention, membrane performance, sanitisation and process monitoring because generation can occur without a high-temperature distillation step. Distilled WFI systems also require appropriate monitoring, and the final programme for either technology should be defined through the validated control strategy, system performance and risk assessment.

What is the main difference between multiple-effect distillation and vapour compression?

Multiple-effect distillation uses external steam passed through several evaporator effects, while vapour compression uses mechanical compression to recycle heat internally. Vapour compression is generally more energy efficient in terms of external thermal-energy demand and can provide greater flexibility in WFI outlet temperature depending on equipment configuration.

Brownfield Pharma Upgrades Without Shutting Down Production

Brownfield Pharma Upgrades Without Shutting Down Production

“Most manufacturers can’t afford to shut down a pharma plant for months. Every day of lost production is lost revenue, extended production interruptions can also affect medicine supply continuity. But older facilities still need new cleanrooms, upgraded HVAC, increased capacity, and equipment and systems aligned with current GMP requirements. That tension is precisely what brownfield pharma upgrades are meant to solve, upgrading a live facility while keeping unaffected operations running wherever technically and GMP-feasible.

In this post, we’ll look at how that actually happens, from planning through construction, in plain language.

What is a Brownfield Pharma Project?

Brownfield projects are projects to expand, renovate, or upgrade an existing facility, often an already in-production facility. This isn’t like a greenfield project, where a new facility is developed without having to retrofit around an existing operating process or facility infrastructure.

There are real constraints to working on the brownfield facility. You are dealing with existing column grids, fixed ceiling heights, and utility entry points that were put in place years ago for a different process. Plus, the site usually needs to continue making products and maintaining GMP control and inspection readiness while the construction crew is there.

Why Keeping the Plant Running Is So Hard

There are a couple of things that make this particularly challenging:

  • Increased risk of contamination: Dust, vibration, and open construction zones near a cleanroom can jeopardise product quality if not carefully managed.
  • Personnel and material flow must remain controlled: Operators still have to go through the building, and materials still have to reach the production areas through controlled and appropriately segregated routes without uncontrolled crossover with construction activities. FDA 21 CFR 211.42 requires material and component flows through pharmaceutical buildings to be designed to prevent contamination.
  • Shared utilities create critical interfaces: Power, compressed air, water systems, and HVAC often feed both the operating area and the area being upgraded, so a mistake in one can impact the other.
  • Regulatory documentation must be kept current: As the facility changes, even if it is still operating, change control, affected qualification and validation documentation, SOPs, and the Site Master File where applicable and where the changes affect its contents need to be updated. EU GMP Annex 15 requires planned changes that may affect product quality to be formally documented and their impact on the validated status or control strategy assessed. PIC/S also states that a Site Master File should be regularly reviewed so that it remains representative of current activities. https://health.ec.europa.eu/document/download/7c6c5b3c-4902-46ea-b7ab-7608682fb68d_en

These are not new issues for experienced project teams, but they do call for a different playbook than starting with a blank slate.

How to Plan Brownfield Upgrades Without Shutting Down

How to Plan Brownfield Upgrades Without Shutting Down

Here is a practical order to keep production running during a brownfield project:

  1. First, do a full facility audit: Assess the building structure, existing utility capacity, cleanroom classifications, and current validation status before any design work begins. Existing drawings, HVAC zoning and pressure relationships, personnel and material flows, equipment interfaces, and available shutdown windows should also be verified where relevant. Where the proposed change may affect product quality or the validated state, it should be formally assessed through change control and Quality Risk Management. This is the foundation for all subsequent decisions.”
  2. Divide the project into phases: Break the work into sections that can be done one at a time instead of doing one large renovation so that only a small part of the plant is offline at any one time.
  3. Keep construction and production areas physically separated: Temporary walls, sealed barriers, and dedicated construction corridors keep dust and people away from live manufacturing areas.
  4. Arrange utility tie-ins during planned downtime: Critical tie-ins to shared power, water, HVAC, compressed air or other GMP-supporting utilities should be executed during approved shutdown, maintenance or controlled cutover windows where required, with appropriate isolation, sequencing and contingency planning. Not every tie-in requires the entire facility to stop production; the extent of shutdown should depend on the affected system, available redundancy, segregation and documented risk assessment. EU GMP Annex 15 requires planned facility and utility changes that may affect quality to be documented and assessed using a risk-based approach.
  5. Update documentation along the way: As construction proceeds, change control records, SOPs, and affected qualification and validation documents are updated through controlled procedures, rather than being retrospectively corrected after execution. Significant changes to an approved qualification or validation protocol during execution should be documented, scientifically justified and handled through the applicable deviation or change procedure. EU GMP Annex 15 specifically requires qualification and validation documentation to be approved and significant changes to approved protocols during execution to be documented and justified.
  6. Re-qualify affected systems before returning them to GMP use: When a section is finished, the affected facilities, utilities, equipment and systems undergo the required commissioning, qualification and/or validation activities before production resumes there. The extent of requalification should be based on the change-impact assessment and Quality Risk Management, rather than assuming that every system requires the same level of requalification. Properly segregated work on another phase may continue where the documented risk controls allow it. EU GMP Annex 15 states that qualification and validation scope should be based on justified and documented risk assessment and recognises requalification where applicable.

For sterile manufacturing areas, brownfield modifications should also be assessed against the facility’s Contamination Control Strategy (CCS), including potential impacts on premises, HVAC, airflow, pressure relationships, utilities, personnel and material movement, cleaning, monitoring and qualification. EU GMP Annex 1 requires a facility-wide CCS and states that changes to contamination-control systems should be assessed for their impact on that strategy.

Arrange Utility Tie-Ins During Planned Downtime

Techniques That Keep Production Running

Techniques That Keep Production Running

Some particular methods are consistently useful on well-planned brownfield jobs:

  • Construction in segments or phases: The plant doesn’t have to shut down entirely, only part by part, by breaking the project into phases.
  • Temporary containment barriers: Partitions are sealed, and where justified by the contamination-control strategy and pressure design, construction areas may be maintained at a lower pressure relative to adjacent controlled areas to help contain dust and particles, provided this does not compromise the established cleanroom pressure cascade or airflow pattern. FDA GMP requires appropriate control of air pressure and dust where relevant, while EU GMP Annex 1 makes pressure relationships dependent on facility design, contamination risk and containment requirements rather than prescribing negative pressure universally.
  • Separate construction access ways: Contractors and materials are provided with a separate entry and exit path so that they do not cross paths with production staff wherever practicable .
  • Weekend and off-hours working windows: Loud or otherwise disruptive work, such as cutting into walls or running new ductwork, is often scheduled outside of normal production shifts.
  • Modular or pre-fabricated components: By building pre-fabricated utility assemblies, ductwork sections, cleanroom components or skid-mounted equipment off-site and then quickly installing them on site, construction crews spend less time inside the operating facility.

Common Risks During Live Facility Upgrades

Some risks are so frequent that they deserve planning attention from day one:

  • Underestimating utility capabilities: New equipment or line expansions often require more power, compressed air, or water than the existing system was designed to provide.
  • Poor phase-to-phase sequencing: If an upgraded area is returned to GMP use before the required commissioning, qualification, validation and applicable quality release activities are complete, you can create compliance gaps that become difficult to resolve later. EU GMP Annex 15 requires qualification and validation activities to follow planned and approved stages and allows formal release to subsequent qualification stages based on documented assessment.
  • Poor communication with production teams: Construction schedules that do not reflect actual production runs cause conflicts and delays on both sides.
  • Incomplete as-built documentation: In older facilities, the drawings may be obsolete, and planning gets bogged down until a new survey fills in the blanks.
  • Treating contamination control as an add-on in construction: Any short-term disturbance of dust or airflow in the vicinity of a live cleanroom can threaten the controlled environment and potentially product quality. GMP requirements emphasise control of contamination, dust, ventilation and airflow within pharmaceutical manufacturing environments.

Pharma Construction and Installation Services That Support This Work

Brownfield projects require construction teams who know how to work in a live GMP environment, not just how to build.” Pharma construction and installation services focused on this type of work typically have experience with phased scheduling, containment barriers, and working around active production, rather than treating each project as a greenfield build.

Pharma Access supports greenfield and brownfield pharmaceutical projects through integrated engineering, procurement, construction and installation, project management, commissioning, qualification and validation capabilities. Coordinating engineering design and construction within an integrated project team can help keep the phasing plan, utility tie-ins and qualification schedule aligned instead of treating these as separate interfaces when the plant cannot accommodate a prolonged shutdown.

Pharma Access’s construction and CQV capabilities cover pharmaceutical HVAC, utilities, cleanrooms, mechanical, electrical and piping installations together with qualification and validation support.

Why Brownfield Projects Need Integrated Pharmaceutical Engineering

Brownfield projects often involve more live interfaces and simultaneous disciplines than a comparable greenfield build, because the plan has to take the existing structure, live operations, and updated regulatory expectations all into account together. An experienced pharmaceutical engineering team that has done this type of project before knows what to look for in the audit phase and where older facilities tend to have issues, be it aging HVAC, limited utility capacity, or gaps in the existing qualification and validation status.

For a pharmaceutical manufacturer, the choice between a plant upgrade and a greenfield project is often driven by factors such as time, budget, available utility capacity, future expansion requirements, production-disruption risk, and the ability of the existing site to meet the technical needs of the new process. An engineering partner who has done greenfield and brownfield work can clearly lay out that comparison before construction locks in decisions that are costly to change later.

Wrapping Up

Production can often continue in unaffected areas while critical interventions are confined to planned shutdown or cutover windows. First, audit the facility; break the project into phases; keep construction physically separate from live areas; and qualify affected systems before they are returned to GMP use.

This way, a plant can add capacity, meet new GMP standards, or modernise ageing systems while reducing the duration and extent of shutdowns rather than assuming that every brownfield project can proceed with zero interruption. EU GMP Annex 15 supports a lifecycle and risk-based approach to qualification, validation and facility design changes, while FDA GMP requirements focus on protecting manufacturing operations from contamination and maintaining appropriate environmental controls.

Frequently Asked Questions

What does brownfield mean in pharma manufacturing?

‘Brownfield’ means taking an existing pharmaceutical facility and either growing it, renovating it, or upgrading it, often one that is still operational. That’s unlike Greenfield construction, where a new facility is developed without having to work around an existing operational manufacturing facility and its installed systems.

Can a pharma plant stay operational during a brownfield upgrade?

In many brownfield projects, unaffected areas of the plant can remain operational. This usually involves phased construction, physical separation of the work and production areas, and scheduling utility hook-ups around active manufacturing. Whether production can continue depends on the scope of work, shared utilities, contamination risks, existing facility configuration and the ability to maintain adequate segregation and environmental control.

How long does a brownfield pharma project usually take?

There is no standard duration. A targeted brownfield upgrade may be shorter than a greenfield build because existing infrastructure can sometimes be reused, but heavily phased work in a live GMP facility can also require a longer execution period because the work has to be coordinated around production schedules, shutdown windows, system cutovers and qualification activities.

What is the biggest risk in a brownfield pharma upgrade?

One of the biggest concerns is the risk of contamination from construction activity near live production areas, as well as underestimating the capacity of utilities and poor sequencing between project phases. For sterile manufacturing, impacts on airflow, pressure relationships and the site’s Contamination Control Strategy also require careful assessment.

Should a pharma company choose brownfield or greenfield for expansion?

It depends on the timeline, budget, existing utility capacity, facility constraints, future expansion requirements, production-disruption risk, and whether the existing site can support the new process technically. A facility engineering consultant can evaluate both options against your production schedule before you commit.

How Pharma Supply Chain Consulting Helps Close Complex Gaps

Pharma Supply Chain Consulting Helps Close Complex Gaps

The average duration of an active drug shortage had grown to more than five years, according to the United States Pharmacopeia’s 2026 Annual Drug Shortages Report, which assessed shortages active at the end of 2025. That number alone tells you something has changed. Drug shortages may begin with a plant closure, manufacturing-quality issue, production delay or shortfall in a critical raw material. Many now persist for years because the causes are more complex than a single supplier, manufacturing site or country.

This is the environment that pharma supply chain consulting is designed to address. This article breaks down where the gaps really come from, what a consulting partner does about them, and why the solution often extends to how pharmaceutical manufacturing capacity is planned and built in the first place.

Where the Gaps Actually Show Up

Most pharmaceutical supply chains look good on paper until one link breaks. Research published by USP in 2026 found that 44% of drugs in shortage had at least one key starting material, or KSM, manufactured solely in a single country, typically China or India. This sort of concentration implies that a single export restriction, plant inspection failure, or natural disaster can affect all manufacturers relying on that one source simultaneously.

Add tariff and trade-policy volatility to that risk. A survey conducted in February 2025 by the Biotechnology Innovation Organization found that nearly 90 per cent of U.S. biotech companies relied on imported components for at least half of their FDA-approved products. For affected manufacturers, changes in trade policy can alter material costs, lead times and the commercial viability of established sourcing models.

And most companies don’t plan for this ahead of time. A 2026 Operations Outlook survey from Argon & Co surveyed more than 800 senior executives across major global markets and found that only 22% of global pharmaceutical companies were actively performing risk assessments for geopolitical threats at the end of 2025. Here’s why that matters: Supply chain gaps seldom announce themselves early. When it shows up as a stockout, the company is already reacting, not strategising.

What Pharma Supply Chain Consulting Actually Does

A good consulting partner follows a fairly consistent sequence, whether the client is a small biotech or a large manufacturer:

  1. Follow the supply chain down to the raw material level. This means examining not only API suppliers, but also the key starting materials and critical intermediates behind them, as that is often where concentration risk lies.
  2. Evaluate suppliers based on risk, not just cost. This includes single-source dependencies, geographic concentration, quality history, capacity, lead times and financial stability.
  3. Develop dual- or multiple-sourcing plans for the highest-risk inputs, supported by realistic timelines for auditing, testing, qualification and regulatory implementation.
  4. Model safety-stock requirements against working-capital constraints. Holding several months of API inventory may reduce exposure, but it can also tie up capital and introduce shelf-life, storage and material-release considerations.
  5. Link supply chain decisions to manufacturing capacity and determine whether existing facilities, expanded capacity or new facilities will be required to support diversified sourcing.

For regulated products, qualifying an alternate API source may also require an assessment of impurity profiles, physical properties, process performance, stability data and the applicable regulatory reporting pathway. An alternate supplier cannot always be introduced through a procurement decision alone.

That last point is where supply chain consulting and facility strategy start to overlap, and it’s worth spending some time on it

Connecting Supply Chain Strategy to Custom Pharma Facility Design

The strength of a diversified sourcing plan is only as strong as the manufacturing capacity and quality systems  behind it. If a company qualifies a second API supplier and its equipment, process or facility cannot accommodate the material characteristics or associated manufacturing requirements, the diversification plan may be delayed or require additional investment.

That’s what flexible pharmaceutical facility design helps address. A facility built around one process line, with no flexibility to do another formulation or a new dosage form, forces a company to be tied to its existing supplier relationships, whether it wants to be or not. A facility with modular process suites, expandable utility capacity, appropriate containment, spare electrical and automation capacity, and planned space

This link is often overlooked. The supply chain teams build the sourcing plan. Facility teams build the manufacturing infrastructure. If the two don’t talk early, the physical facility is the constraint that keeps a good sourcing strategy from working.

Why Turnkey Construction Firms Matter to Supply Continuity

When a company determines that it needs new or expanded capacity to support supply chain resilience, speed and accountability are both important. That’s where pharmaceutical turnkey construction partners come in.

One accountable partner for scale-up

With one company coordinating design, procurement, construction, installation and CQV within an integrated project scope, you remove the handoff gaps that can slow a project down. A fragmented project team with unclear ownership can add project-delivery risk at a time when a supply disruption is already affecting production, inventory or commercial commitments.

Faster time to qualified capacity

Off-site modular construction methods available through selected pharmaceutical turnkey partners can compress parts of the project schedule by allowing module fabrication, site preparation and infrastructure work to progress in parallel. If you’re a company racing to qualify a new supplier and establish the manufacturing capacity required to support it, schedule coordination can affect whether additional qualified capacity is available when it is needed.

The final time to operational readiness will still depend on equipment lead times, technology transfer, site conditions, commissioning, qualification, process validation and regulatory requirements.

Energy Resilience in Modern Pharma Facilities: A Hidden Supply Chain Risk

Energy Resilience in Modern Pharma Facilities: A Hidden Supply Chain Risk

Risk in the supply chain doesn’t stop with raw materials. Energy is part of the chain too, and it’s often overlooked. Energy-price volatility, utility interruptions and disruptions to fuel or transport networks can increase manufacturing costs, affect temperature-controlled logistics and delay pharmaceutical production.

This fact should be directly included in the energy-planning strategy for a modern pharmaceutical facility. Facilities that are fully reliant on a single power source or utility configuration may carry an operational-continuity risk that resembles other forms of supply concentration. Backup generation,UPS support for critical systems, resilient utility design, on-site energy monitoring and efficient HVAC systems all provide additional protection against the types of disruption that can affect production continuity.

HVAC systems in pharmaceutical cleanrooms can be highly energy intensive because they must maintain controlled airflow, filtration, temperature, humidity and pressure relationships. However, the exact energy profile will depend on the process, cleanroom classification, utility systems and facility design.

What to Look for in Pharma Turnkey Consultants

Not all consultants or construction partners link supply chain thinking with facility planning. distinguishes partners that take an integrated approach.

  • They ask you about your sourcing strategy and future capacity requirements before they draw a single floor plan.
  • Instead of a single, fixed line, plan flexible process capacity, expandable utilities and future equipment interfaces where the business case supports them.
  • They design energy resilience from the start, not as an afterthought.
  • They have documented experience in multiple dosage forms and geographies.
  • They can demonstrate experience through previous projects where facility design supported a capacity, expansion or operational-continuity requirement.

Pharma turnkey consultants who treat facility design and supply strategy as one conversation, rather than two separate ones, are better positioned to deliver facilities that support the resilience objectives established by business and operations leadership.

Where Pharma Access Fits Into This Picture

Where Pharma Access Fits Into This Picture

Pharma Access, headquartered in Mumbai, provides pharmaceutical engineering design, procurement and supplies, construction and installation, CQV and project management services for pharmaceutical and biotechnology facilities. The company integrates engineering and execution within a coordinated project-delivery model, allowing capacity, process flexibility, utility resilience and future expansion requirements to be considered alongside facility planning.

Its Modular Mobile Facility approach also gives companies an off-site modular option for adding or developing manufacturing capacity where speed, phased expansion or constrained site conditions are important project considerations. Project suitability will depend on the dosage form, production scale, site conditions, regulatory pathway and geography.

Pharma Access does not need to replace the specialist pharma supply chain consultant in this process. Its role is to translate sourcing, capacity and resilience requirements into coordinated pharmaceutical engineering and execution strategies.

Steps to Close the Gaps

  1. Trace your supply chain back to key starting materials, not just finished API suppliers.
  2. Perform a geopolitical and tariff risk assessment at least annually.
  3. Create a facility design brief that considers future sourcing changes, not only current production.
  4. Compare pharmaceutical turnkey partners not only on price, but also on flexibility, technical capability, CQV integration, project accountability and speed.
  5. And don’t think of energy resilience as just another utility item within your supply chain risk plan.

Frequently Asked Questions

What is pharma supply chain consulting?

It’s advisory work that charts sourcing risk across API, key starting material, supplier, manufacturing-capacity  and logistics networks and then develops diversification, inventory, and facility strategies to lower the risk of a disruption turning into a shortage.

Why do drug shortages keep lasting longer even as their total number declines?

Many shortages are now driven by structural problems, such as geographic concentration in key starting materials, manufacturing-quality issues, limited production capacity, product discontinuations and thin profit margins that limit investment in resilience, rather than one-off events that resolve quickly once fixed.

How does facility design affect supply chain resilience?

A facility with flexible process capacity enables a company to take advantage of a diversified sourcing plan. A rigid, single-line facility can tie a business to existing processes, equipment configurations and capacity limitations even after new ones are qualified.

Do small biotech companies need supply chain consulting, or is it only for large manufacturers?

Small biotechs can be particularly exposed because they may operate with tighter working-capital limits and depend on a small number of suppliers, CDMOs or logistics routes. Consulting helps them prioritise which risks to address first without overspending on unaffordable safety stock or unnecessary infrastructure.

How does energy volatility connect to pharmaceutical supply chains?

Pharmaceutical production is an energy-intensive process, and local energy interruptions or price volatility can increase production costs, disrupt critical utilities, affect cold-chain operations and delay output. This risk is reduced for facilities with backup power, resilient utility systems, energy monitoring and efficient HVAC design.

Turnkey Construction Firms for Energy-Efficient Pharmaceutical Facilities: What to Look For

Turnkey Construction Firms for Energy-Efficient Pharmaceutical Facilities

A pharmaceutical factory does not operate like a normal factory. Cleanrooms require controlled filtered airflow, defined temperature and humidity ranges, and pressure regimes appropriate to the product, process and containment strategy. That kind of precision comes at a cost. Research published in the Journal of the International Society for Pharmaceutical Engineering, found that HVAC systems can account for between 36% and 67% of total facility energy consumption, depending on the process, cleanroom classification and operating conditions.

That single number is why so many pharma companies now evaluate their turnkey construction firms on energy performance, not just square footage and timelines. So let’s examine it. What’s driving these costs? What does a turnkey partner actually do? And how do you choose one that builds in efficiency from day one, introducing it through later-stage modifications?

What’s Driving Modern Pharma Facility Energy Costs

What's Driving Modern Pharma Facility Energy Costs

Pharma plants are significantly more energy-intensive than most buildings. As a consulting-specifying engineer summarised in 2019, “The average energy use intensity of a typical commercial office built after 2000 is roughly 81.4 kBtu per square foot per year, while the average pharmaceutical plant is around 1,210 kBtu per square foot per year.”That gap is from cleanroom conditioning, process equipment, and utility generation operating for extended periods. These figures represent a broad US comparison, and actual energy performance can vary substantially by process, climate, classification and operating schedule.

This is why HVAC takes so much of that load. The fans, filters, chillers, and dehumidifiers that do that job may operate continuously or for extended periods, depending on the area and manufacturing schedule, and cleanrooms need controlled ventilation to maintain specified environmental conditions and airborne-particle limits. Cleanroom energy benchmarking research has found that HVAC use in cleanrooms accounts for between 36% and 67% of the total facility energy, depending on the process. When a construction partner discusses modern pharma facility energy costs, the conversation will usually begin with air-handling design.

The good news is that high energy use is not entirely fixed as an unavoidable cost of doing business. For example, in a case where Roche and Genentech reduced air change rates in an existing facility using a multidisciplinary, risk-based assessment, the project reduced airflow volume and resulted in a 14% reduction in energy use and greenhouse-gas emissions, with annual savings of more than $678,000. Such results can be supported by making the right design choices at the construction stage while also reviewing existing systems through risk assessment, monitoring, change control and requalification where required, which is precisely where experienced turnkey partners can add value.

What Turnkey Construction Firms Actually Do

Turnkey companies may take a pharma project from concept development to a qualified, operating facility. In practice, that means five phases, generally:

  1. Engineering design – process flow, cleanroom classification, HVAC, and utility layout specific to dosage form.
  2. Procurement – purchase of manufacturing equipment, machinery, and building materials.
  3. Construction and installation – civil, structural, mechanical, electrical, and plumbing work on site
  4. Commissioning, qualification, and validation (CQV) – confirming that systems function as intended, providing documented evidence that facilities, utilities and equipment meet approved requirements, and supporting applicable process-validation activities.
  5. Project management – keeping the budget, schedule, and all moving contractors on track.

FDA guidance describes process validation as a lifecycle activity that establishes scientific evidence that a manufacturing process can consistently deliver quality products. Qualification of facilities, utilities and equipment forms part of that lifecycle, but responsibility for product quality and the validated state remains with the manufacturer and its Quality Unit.

The attraction is simple. The owner gets a single point of accountability for pharmaceutical facility design and construction from concept to handover rather than dealing with a design firm, builder, equipment vendor, and validation consultant separately.

How to Choose the Right Partner

How to Choose the Right Partner

Not all construction companies offering “turnkey” delivery demonstrate the same capability in energy-performance design. This is what really distinguishes the ones that do from the ones that cannot demonstrate it through documented project evidence.

Track record across dosage forms

Biotech, sterile injectables, oral solids, and API plants have different cleanroom classifications, process risks, containment strategies and HVAC requirements. A company that has only built oral solid dosage plants may not have the airflow modelling experience needed for a sterile injectable facility. Request for project references related to your specific dosage form and scale.

ISO 14644-1 classifies cleanrooms by airborne-particle concentration, while the wider contamination-control, process and regulatory requirements determine how the facility and its HVAC systems should be designed and operated.

In-house engineering, not just subcontracted labor

Companies that have in-house HVAC, process, and MEP (mechanical, electrical, and plumbing) engineering usually catch energy waste earlier, at design, when it’s cheapest to fix. Concrete is expensive to change once it is poured, and an oversized air handling unit is no exception.

Sustainability built into design, not added later

Ask how the firm deals with validated airflow-setback strategies in suitable areas, variable-speed drives on fans and risk-based air-change rates instead of relying on worst-case assumptions. This is consistent with the WHO’s technical guidance on HVAC in non-sterile pharmaceutical manufacturing, which recommends a comprehensive science- and risk-based approach across the HVAC lifecycle, beginning at the initial design stage. Oversized systems can increase capital and operating energy without necessarily improving contamination control.

A real compliance and validation history

An energy-efficient design is of limited value if it does not support applicable regulatory and quality requirements. Look for companies with proven experience across cGMP-focused and regulated-market projects, as well as relevant organisational ISO certifications, established quality systems and documented CQV procedures.

FDA does not generally certify pharmaceutical engineering companies, and GMP should not be presented as a personal certification held by an engineering team. Organisational certifications such as ISO 9001, ISO 14001 and ISO 45001 relate respectively to quality, environmental, and occupational-health-and-safety management systems. Pharma Access states that it holds these three management-system certifications.

The Role of AI for Predictive Maintenance in Pharma Plants

Building is only the beginning. Once a facility is up and running, equipment reliability is the next lever on both energy usage and product quality. A worn pump or drifting compressor is not merely a downtime risk. destabilise environmental or process control and contribute to a deviation.

This is where AI for predictive maintenance in pharma plants has begun to improve maintenance planning. According to industrial predictive-maintenance research, combining AI or analytical models with IoT-enabled sensor data can help teams identify developing equipment faults before failure, supporting planned maintenance and improved operational reliability. The benefits depend on sensor coverage, data quality, equipment criticality, system integration and the engineering and financial suitability of the application.

So the bottom line for a facility owner is to ask your construction partner if the building is being designed for sensor infrastructure and appropriate BMS, EMS, equipment-control, historian and maintenance-system integration from day one. Retrofitting monitoring hardware into finished cleanrooms is a far more disruptive process than wiring it in during construction. Network-based access to real-time manufacturing-system data can also support maintenance and troubleshooting, subject to appropriate access control, cybersecurity and GxP data-governance requirements.

Where Engineering Consulting Services Fit In

Not every project requires a full turnkey contract. Some owners engage engineering consulting services for a more limited scope, such as HVAC optimisation, cleanroom layout review, or a feasibility study, before committing to a full build. This path is well-suited for brownfield expansions or facilities that require only targeted upgrades rather than ground-up construction.

The price is coordinated. The owner would still have to separately manage the builder, equipment vendors, and the validation team with only consulting support. A turnkey model rolls all of that under one contract, which tends to reduce the number of handoffs where miscommunication (and cost overruns) creep in.

A Look at How This Plays Out in Practice

A Look at How This Plays Out in Practice

Pharma Access is a Mumbai-based pharmaceutical engineering and turnkey construction company that has been working on biotech, sterile manufacturing, oral solid dosage and API projects for more than 25 years. Its service offering covers the entire chain: engineering design, procurement, construction and installation, CQV and project management, all under one roof. The firm has also developed a Modular Mobile Facility approach, designed to support controlled off-site fabrication, parallel execution, faster site installation and scalable facility delivery compared with fully site-built approaches, where suitable for the project. Pharma Access currently states that it has completed more than 120 projects for over 100 clients across 18+ countries.

The point is there is more than one firm to choose from. It’s the delivery capability that counts, not the marketing. Compare Pharma Access with other qualified project partners and ask the same questions. Who does the HVAC modelling? Who supports CQV delivery, and how are responsibilities divided between the partner, owner and Quality Unit? And what about the design plan for energy use during the next twenty years, not just at initial project handover?

Questions to Ask Before You Sign

  • Do you have energy modelling data from a previous similar project?
  • How do you determine and justify airflow quantities and air-change rates for our particular process, room classification and contamination-control requirements?
  • Does the base design incorporate predictive maintenance infrastructure, or is it added later at extra cost?
  • What organisational ISO certifications, regulated-market project experience and quality systems do you have, and can we see supporting evidence?
  • Who supports CQV activities? Is it an internal team or outsourced?

Next steps: Choose two or three firms to be your finalists, ask for references on your dosage form, and compare their answers to the side-by-side questions above. Usually, the difference between a good answer and a vague one tells you everything you need to know.

Frequently Asked Questions

What makes a construction firm “turnkey” in pharma projects?

A turnkey company manages an integrated project scope that may include engineering design and procurement through construction, CQV support and project management under one contract. The owner has one primary accountable project partner, instead of coordinating separate vendors for each phase, although the precise responsibilities must be defined in the contract.

Why do pharmaceutical facilities use so much more energy than office buildings?

Cleanrooms require controlled volumes of filtered air, defined temperature and humidity conditions, and pressure differentials between selected rooms to control contamination or provide containment. This keeps HVAC systems running for extended periods and, in some critical areas, continuously, which is why pharma plants use far more energy per square foot than standard commercial buildings.

How does AI-based predictive maintenance actually save money in pharma plants?

Sensors monitor the condition of equipment in real time and signal the first signs of wear or abnormal performance. This allows teams to plan repairs before a functional failure occurs, helping to reduce the risk of unplanned downtime, emergency repairs, process disruption and associated deviations. The value depends on equipment criticality, sensor selection, data quality and the maturity of the maintenance system.

Should I hire a turnkey firm or separate engineering consulting services?

It depends on the scope. For a full new build, a turnkey contract may be more suitable when the owner wants integrated coordination across multiple disciplines. Standalone engineering consulting services often work well for a targeted upgrade, such as an HVAC retrofit, or when the owner has the internal capability to manage the remaining contractors and vendors.

How long does a turnkey pharmaceutical facility project typically take?

For example, a targeted upgrade may take several months, whereas a large greenfield biotech plant could take several years. These timelines can vary considerably depending on facility size, dosage form, regulatory region, site readiness, long-lead equipment, owner approvals and CQV scope. In some cases, selected design, fabrication and installation activities can be reduced with modular construction procedures.

Turnkey Pharmaceutical Plant in Saudi Arabia: 10 Critical Stages

Turnkey Pharmaceutical Plant in Saudi Arabia: 10 Critical Stages

Turnkey Pharmaceutical Plant in Saudi Arabia projects are becoming increasingly important as Saudi Arabia develops one of the most ambitious pharmaceutical industries in the Middle East. The Kingdom’s pharmaceutical market reached a value of about USD 11.6 billion in 2024. Around 30% of pharmaceutical products are manufactured locally, according to official Saudi investment material. That figure has a clear target under Vision 2030: to localise 40% of the market value in the pharmaceutical industry through domestic manufacturing investment, industrial zone development, and technology transfer partnerships.

Pharma companies looking to enter or expand in the Saudi market often find themselves asking one question early on: what does it actually mean to set up a compliant, production-ready plant? For most projects, the answer is a Pharma Turnkey Solutions in Saudi Arabia, an integrated project-delivery model that covers all stages from initial design to qualified and documented handover.

Here’s a look at what’s in that model, why it matters in the Saudi context, and what investors and manufacturers need to know before they begin the project.

1. Why Saudi Arabia Demands a Turnkey Approach

Building a pharmaceutical facility is not the same as building a typical industrial warehouse.

 The Saudi Food and Drug Authority (SFDA) GMP Guidelines aligned with internationally recognised GMP principles, including applicable PIC/S guidance.
All room classifications, airflow patterns, surface finishes and drainage points must be designed according to the dosage form, process and contamination-control requirements. The SFDA conducts site inspections, with the duration depending on the facility scope and complexity, and can issue non-compliance findings that can delay licensing, GMP certification or related regulatory activities.

With a turnkey approach, one engineering partner handles the full scope: design, procurement, construction, installation, commissioning, and qualification and validation (CQV). That one point of responsibility reduces the gaps in coordination that happen when you have more than one contractor working separately. When all disciplines report to one team, compliance is designed from day one, not corrected at the end.

Vision 2030 aims to localise 40% of the market value in the pharmaceutical industry. Companies that can quickly and compliantly commission facilities will be best positioned to capture that growth.

2. Pre-Project Feasibility and Site Assessment

Every turnkey pharmaceutical plant in Saudi Arabia starts a long way before the first brick is laid.

The feasibility phase includes the following:

  1. Site assessment – evaluating availability of land, classification of industrial zone, proximity to utilities, site-access requirements and capacity of local infrastructure
  2. Regulatory mapping – what SFDA licensing and registration pathways https://www.sfda.gov.sa/en/news/88414 are relevant for the product type (e.g., oral solid dosage, sterile injectables, biologics, API, etc.)
  3. Production capacity planning – determining batch sizes, room requirements, equipment capacities and throughput demands from market forecasts
  4. Budget framework — preparing a capital expenditure estimate prior to detailed design

A typical greenfield pharmaceutical facility, from concept approval to first product batch, may take 3 to 5 years. This may include design (6-12 months), construction (12-24 months), and CQV (12-18 months) although activities may overlap and timelines depend on project complexity, equipment lead times and regulatory requirements.Modular construction approaches can reduce selected project phases when design standardisation, site readiness, approvals and logistics are properly coordinated.

A detailed upfront feasibility assessment helps keep the timeline on track and avoids costly redesigns down the line.

3. Engineering Design — the Foundation of GMP Compliance

The principle is straightforward.
Good manufacturing practice is not something you tick off at the end of the day. It is a core design consideration. Every choice in the engineering phase, from room pressure differentials to floor drain placement, either helps or hurts the regulatory outcome.

A full pharma engineering solution package in Saudi Arabia comprises the following:

  • Process design — setting up production workflows, room adjacencies, and personnel, material, product and waste-flow paths to prevent cross-contamination
  • Architectural and structural design – selection of wall systems, types of ceilings, floor coatings, and door specifications to meet cleanroom requirements;
  • HVAC design — engineering heating, ventilation, and air conditioning systems to maintain the required cleanroom grades or controlled environmental conditions,  temperature, humidity, and differential pressure
  • MEP systems – mechanical, electrical, and plumbing design, including compressed air, nitrogen, clean steam, and Water for Injection where required by the process.
  • Automation and IT – Building Management Systems (BMS), Environmental Monitoring Systems (EMS), and SCADA Integration
  • ELV systems – access control, CCTV, and fire and life safety systems
  • Quality control laboratory – a dedicated, appropriately controlled QC laboratory for in-process testing and batch release

Today, pharmaceutical engineering solutions utilise simulation-based tools before the construction phase. GMP compliance is designed into the project rather than retrofitted into the project later in the project lifecycle, with more sophisticated simulation tools to model HVAC performance, room classification, and material flow paths by engineering teams.

Digital-twin technology is also being evaluated in pharmaceutical manufacturing projects. Turnkey companies may develop these simulation models as part of the design package, giving the client a virtual facility to stress-test before a single beam is put up.

4. Procurement and Supply Chain Management

Pharmaceutical process equipment is not a ready-to-use item. The tablet press machines, isolators, autoclaves, WFI generation systems, and cleanroom air handling units all come from specialised suppliers with different technical capabilities, documentation standards and delivery timelines. Mistakes in procurement, such as purchasing equipment that does not meet the approved User Requirement Specification or cannot support documented qualification, can cost months of delay.

A turnkey project covers procurement for the following:

  • Manufacturing process equipment (granulators, coaters, fillers, capsule filling machines, lyophilisers, etc., depending on the dosage form)
  • Utility equipment (water purification systems, clean steam generators, compressed gas systems)
  • Cleanroom panels, doors, and pass-through systems
  • HVAC air handling units and filtration
  • Analytical equipment and laboratory instruments
  • Automation Equipment (PLCs, SCADA, DCS)

In turnkey pharmaceutical projects, the procurement process favours the use of technically evaluated and qualified suppliers and equipment with a history of success in the pharmaceutical sector and documentation that supports GMP qualification.

Procurement for a turnkey pharmaceutical plant in Saudi Arabia also involves customs documentation, clearance through the Zakat, Tax and Customs Authority (ZATCA), and liaison with local freight agents. Part of the scope is an experienced turnkey partner who handles all of this in accordance with the agreed procurement and logistics responsibilities.

5. Construction and Installation

Construction and Installation

GMP facility construction is unlike your typical civil construction in several ways. 1. Materials must be traceable. Cleanroom panels need to be installed in a controlled sequence. HVAC ductwork must be protected from contamination and internally clean before installation. Any change from the approved design must be handled through a formal change-control process.

The construction phase consists of:

  • Civil, Structural & Foundation Works
  • Installation of cleanroom wall, ceiling, and floor
  • HVAC ductwork fabrication and installation
  • Piping and plumbing of process and utility services
  • Installation of lighting and electricity
  • Fire suppression and life safety systems
  • Site infrastructure and landscaping

During the construction phase, strict quality assurance practices are followed to ensure the integrity of the cleanroom and the traceability of the materials. The construction teams also work closely with engineering and validation units to maintain quality checkpoints such as material inspections, installation checks, duct-cleanliness inspections, pressure testing and punch-point closure.

In Saudi Arabia, construction must also adhere to applicable Saudi Building Code requirements, SASO standards, and coordinate with municipal authorities for permits and inspections.

6. Pharma Effluent Treatment and Waste Management

“Here is an area that investors sometimes underestimate until it becomes a project or environmental-compliance issue.

One of the most important requirements for pharmaceutical factories in the Kingdom of Saudi Arabia is an approved wastewater-management strategy appropriate to the effluent characteristics and site conditions. Active pharmaceutical ingredients (APIs), solvents, and cleaning agents present in the wastewater must be treated to acceptable concentrations before discharge to the drainage system, in accordance with the applicable permit and discharge limits.

Depending on the industrial zone, available infrastructure and wastewater characteristics, this may involve on-site treatment, pretreatment before discharge or connection to an authorised central treatment system.

A typical pharmaceutical effluent-treatment system may include the following:

  • Pre-treatment (pH neutralization, solids removal)
  • Biological treatment (activated sludge, MBBR, or MBR technology)
  • Tertiary treatment (filtration, disinfection)
  • Re-use options for treated water (cooling systems, irrigation, cleaning)

Advanced membrane bioreactor (MBR) technology provides high-quality treated water without chemicals and produces clear, low-suspension output that is suitable for reuse in cleaning, cooling, and landscaping applications. These systems are ideal for new pharma plants or upgrades to existing facilities in Saudi Arabia and the UAE.

A properly designed system for treating the effluent is necessary where required by the environmental permit and discharge conditions. It is not a universal standalone condition of the SFDA manufacturing licence, although the facility must comply with all applicable environmental and industrial-zone requirements.

7. Commissioning, Qualification, and Validation (CQV)

Commissioning, Qualification, and Validation (CQV)

This is the point at which documented evidence is generated to support the facility’s GMP readiness. CQV is a systematic process to demonstrate that all systems, rooms, and equipment operate as required, within the limits necessary for drug production.

Let’s break it down into three stages:

  • Commissioning – Ensuring all systems are installed properly and functioning as specified by the engineering team.
  • Qualification – the four-step GMP check sequence:
  • Design Qualification (DQ): confirms that the design fulfills approved User Requirement Specification and applicable GMP requirements
  • IQ (Installation Qualification): Equipment is installed and configured according to approved drawings, specifications and manufacturer requirements
  • Operational Qualification (OQ): confirms equipment functions properly across defined operating ranges and control functions.
  • Performance Qualification (PQ): confirms that the equipment can consistently deliver results under normal manufacturing conditions
  • Validation – Process validation, cleaning validation, and computer system validation (CSV) of any software-controlled equipment or systems.

In the pharmaceutical industry, turnkey solutions are typically handled via EPC (Engineering, Procurement, Construction) or EPCM contracts.


These are different delivery models. Under EPCM, the provider manages engineering, procurement and construction activities on behalf of the owner rather than acting as the construction contractor.
In the EPC turnkey model, the provider assumes the responsibilities and risks allocated in the contract, and GMP-compliant validation support may form part of the turnkey handover, depending on the agreed scope. In technical commissioning, a clear distinction is made between the Factory Acceptance Test (FAT) at the manufacturer’s plant and the Site Acceptance Test (SAT) at the final location. FAT and SAT records may support qualification but do not automatically replace IQ or OQ unless this approach is justified and documented.

The documentation package produced by the CQV process is what the SFDA inspectors review during a GMP inspection. It supports the regulatory readiness of the facility.

8. Regulatory Readiness and SFDA Licence Preparation

Setting up a turnkey pharmaceutical plant in Saudi Arabia requires working with the SFDA at every step, not just at the end.

Manufacturers in Saudi Arabia must be licensed by the SFDA. Facilities are regularly audited for GMPs and inspected by regulatory agencies. Domestic and foreign manufacturers are required to comply with the SFDA’s GMP Guidelines, which are aligned with internationally recognised GMP principles and applicable PIC/S guidance. Depending on the manufacturer’s legal structure and registration pathway, a Saudi entity, authorised agent or local representative may be required for specific regulatory activities.

The SFDA inspection team may visit the site to conduct a comprehensive GMP evaluation of relevant production lines, utilities, quality systems and supporting operations. Manufacturing sites can expect a tough three- to five-day assessment.

A turnkey partner with experience in the MENA region can prepare the regulatory documentation of the facility in parallel with the construction so that GMP dossiers are ready when the building is ready.

9. Project Management Across the Full Lifecycle

Project Management Across the Full Lifecycle

A turnkey pharmaceutical plant is not a construction contract. It is a programme management exercise that spans years and involves dozens of specialist disciplines.

Pharma turnkey solutions include dedicated project management covering the following:

  • Master programme planning and schedule control
  • Cost management and change control
  • Risk tracking and mitigation planning
  • Vendor and subcontractor management
  • Document control and regulatory correspondence
  • Commissioning and handover coordination

One central team manages architecture, mechanical systems, and specific process workflows under a single point of responsibility for the entire build. This centralised structure minimises technical errors and prevents costly redesign loops. Engineering teams communicate directly with equipment manufacturers to ensure technical coordination across equipment, utilities and facility interfaces.

Pharma Access, with 25+ years of experience and more than 120 projects across 18+ countries, including projects in Saudi Arabia and other MENA markets, uses this integrated project-management model to support schedule, cost and execution control across complex pharmaceutical projects.

10. What the Turnkey Handover Actually Looks Like

At the end of a well-executed turnkey project, the client receives much more than a set of building keys.

A full turnkey package for a pharmaceutical plant in Saudi Arabia comprises:

  • A fully commissioned facility with systems qualified within the agreed CQV scope and supporting documentation.
  • Complete set of as-built engineering drawings.
  • Maintenance schedules, spare-parts lists and equipment manuals.
  • Facility operating SOPs, where included in the agreed project scope.
  • Qualification and validation protocols and reports according to the agreed project responsibilities.
  • Staff training records for the equipment, utilities and systems covered by the provider.
  • A GMP-compliant regulatory-readiness documentation package.

Thereafter, the client can complete the remaining SFDA manufacturing-licence, GMP-certification, product-registration, technology-transfer and operational-readiness activities. Commercial manufacturing can begin after the required approvals, quality systems, validated processes and product authorisations are in place.

Frequently Asked Questions

What is a turnkey pharmaceutical plant in Saudi Arabia?

A turnkey pharmaceutical plant in Saudi Arabia is a contract for the complete facility setup, where one company is responsible for the design, procurement, construction, installation, and validation. The client receives a facility ready for SFDA GMP inspection and commercial production at handover, without having to deal with multiple independent contractors.

How long does it take to set up a pharmaceutical manufacturing plant in Saudi Arabia?

In a greenfield pharmaceutical plant, it usually takes three to five years from concept to the first batch of production. These include 6-12 months of design, 12-24 months of construction, and 12-18 months of commissioning, qualification, and validation. Although these phases may overlap and the schedule depends on the project scope.

What does SFDA require for pharmaceutical manufacturing approval in Saudi Arabia?

All sites for the manufacture of pharmaceuticals require a GMP licence from the SFDA. Manufacturers are required to adhere to the SFDA GMP Guidelines based on the WHO and PIC/S standards, submit a Common Technical Document (CTD) dossier for each product, and pass a site inspection, including facility design, equipment qualification, documentation systems, and review of the live production line.

Do pharmaceutical plants in Saudi Arabia need effluent treatment systems?

Yes. Pharmaceutical manufacturers must have an approved wastewater-management approach that meets the applicable environmental, industrial-zone and discharge requirements.The facility setup may require on-site treatment, pretreatment before discharge or connection to an authorised central treatment system, depending on the wastewater characteristics and site infrastructure.In the Kingdom, membrane bioreactor technology is one of several treatment technologies that may be considered, depending on the effluent composition, treatment objectives and permitted discharge or reuse conditions.

How does pharma engineering with simulation tools improve a turnkey project?

The project team can model HVAC performance, cleanroom pressure differentials, and material flow paths before construction by using simulation-based engineering. This allows design problems to be found early, when they are easier and less costly to fix, rather than during construction or CQV, when they are expensive and time-consuming to correct.Simulation-based engineering forms part of Pharma Access’s approach to pharmaceutical-facility design and integrated project delivery.

Benefits of Pharma Turnkey Consultancy Services for Your Next Facility Project

Benefits of Pharma Turnkey Consultancy Services Solutions

It is no small feat to build a pharmaceutical manufacturing facility. You need architects who understand GMP facility design and cleanroom classifications , you need engineers who know HVAC systems for controlled and sterile manufacturing environments, and a team that can support commissioning and qualification without fragmented communication between multiple project stakeholders.
This is where pharma turnkey consultancy services come in. Work with one partner who takes care of the design, the build, and the handover within an agreed project scope, rather than working with ten different vendors, hoping they talk to each other.

That is why this approach has become increasingly relevant for pharmaceutical facility projects. Here is what it looks like on a real project.

What This Type of Consultancy Actually Covers

What This Type of Consultancy Actually Covers

The turnkey consultant doesn’t just draw plans and then go away. The scope is usually everything from that first concept sketch to the day you turn the key and prepare the facility for production. That usually involves:

  • Mechanical, Electrical, Plumbing, Cleanroom Layout (Pharmaceutical Facility Design)
  • Procurement of machinery and process equipment
  • Construction and installation
  • Commissioning, Qualification and Validation (CQV)
  • Project management from start to finish

Because one team has all these pieces, you have fewer gaps between design intent and what’s actually built. If the cleanroom drawing does not match what the HVAC contractor installs, that mismatch is caught early rather than during qualification or a regulatory inspection.

Why Pharmaceutical Companies Turn to Turnkey Consultants

One Team, One Contract, One Point of Contact

Divide a facility project into a design firm, a construction contractor, and a validation consultant, and you have the person who has to tie them all together. All change orders may require multiple approvals. Responsibility for every delay can also become unclear. In a turnkey model, one contract covers the whole scope, and one team is responsible for the outcome. If an issue arises, you know exactly who to call.

Shorter Build Times

Shorter Build Times

When design, procurement, and construction are all under one roof, they can be better controlled. The construction crew doesn’t wait weeks to get an answer to a question from a design firm because the engineers sit down the hall. One team follows both timelines to the same master schedule, allowing equipment procurement to begin while civil work is still underway. That overlap could shorten the overall project timeline by several months on a complex facility project.

Regulatory Know-How From the Start

Regulatory Know-How From the Start

Preparing a facility for FDA assessment and inspection is not something you tack on at the end. The Current Good Manufacturing Practice (CGMP) regulations in 21 CFR Parts 210 and 211 outline the minimum requirements for the methods, facilities, and controls used in the manufacture of a drug product.
The inspectors look at the physical building as well as the paperwork and operational systems  to ensure compliance with these rules. The FDA’s review of new and generic drug marketing applications includes an assessment as to whether the manufacturer is in compliance with CGMP. The agency’s assessors determine if the firm has the facilities, equipment, and ability to manufacture the drug it plans to market. Good pharmaceutical engineering consultants integrate cleanroom classifications, airflow design, and documentation practices into the layout from day one, so the building supports an inspection instead of fighting it. In addition to FDA rules, many projects must also comply with WHO good manufacturing practice guidelines, which establish quality standards for production and quality control and require that personnel, premises, and materials be suitable for the production of pharmaceuticals and biologicals, including vaccines.
For API manufacturing projects, ICH Q7 may also be relevant, depending on the product, project location and intended regulatory markets.

The turnkey consultant can support GMP-aligned facility design, qualification and inspection readiness, but the pharmaceutical manufacturer remains responsible for its quality system, regulatory submissions, process validation and ongoing GMP operations.

Budget Certainty

Scope changes are often the cause of facility build cost overruns that no one caught in time. A turnkey partner may quote the defined project scope upfront – equipment, labour, validation, etc. – so you don’t get surprise change orders three months into construction. Of course, you still have to read the contract in detail, but the fact that there is one accountable scope makes it a lot easier to track spend against a fixed baseline. Final project costs can still be affected by client-requested changes, unforeseen site conditions, equipment changes, regulatory requirements and other contract exclusions.

Access to Specialized Facility Design Skills

Sterile injectable lines, biotech suites, and oral solid dosage plants all have different HVAC pressure cascades, material flows, and equipment layouts. Experienced pharmaceutical facility consultants have engineers who have already solved these problems on other projects. That kind of pattern recognition, the ability to know which layout errors lead to validation headaches down the road, is hard to develop in-house unless facility construction is a regular part of your business.

What Sets the Top Pharma Consulting Firms Apart

Not every company that calls itself a turnkey provider actually does end-to-end work. Here’s what to watch for:

  1. Experience with comparable dosage forms: A company that already has oral solid-dose plants may not have the same experience levels in sterile injectables or cell and gene therapy suites. Ask for references of projects that are similar to your product type.
  2. Drawings outsourced, in-house engineering, not only: Companies with their own mechanical, electrical, and process design teams can move faster and catch conflicts before construction starts.
  3. Proper CQV process: Commissioning, qualification, and validation should be planned in parallel with design and not as a final step.
  4. Certifications to support their cases: A company with documented internal processes may hold certifications such as ISO 9001 for quality, ISO 14001 for the environment, and ISO 45001 for health and safety. These certifications should be evaluated alongside relevant project experience, engineering capabilities and client references.
  5. A project management structure you can feel: You want named contacts, not a revolving door of subcontractors.

One company that has built on this model is Mumbai-based engineering and construction firm Pharma Access. With more than 25 years of experience , it has worked on pharma and biotech facility projects in more than 18+ countries, including biotech, sterile manufacturing, oral solid dosage, oral liquid dosage, and API facilities. 120+ projects for more than 100 clients.It is ISO 9001, ISO 14001, and ISO 45001-certified. The point is not that one firm fits all projects. It is the sort of background that is worth checking out before you sign anything.

How Pharma Turnkey Consultants Handle a Project, Step by Step

How Pharma Turnkey Consultants Handle a Project, Step by Step

A typical turnkey engagement typically follows a five-step process:

  1. Feasibility and design concept: The consultant will review your product mix, capacity requirements, and site options and develop an early layout and budget range.
  2. Detailed engineering: Mechanical, electrical, plumbing, and process drawings are finalised, as well as cleanroom classifications and equipment specifications.
  3. Procurement and construction: Equipment was ordered, civil work started, and installation according to the coordinated schedule.
  4. Commissioning, qualification & validation: Facilities, utilities and equipment are tested and qualified for their intended use.Documentation is compiled. The facility is prepared for regulatory inspection.
    Process validation activities are completed by, or in coordination with, the manufacturer’s quality and production teams.
  5. Handover and support: Operators are trained, and the facility is handed over to your production team.
  6. This is an important order: One of the most common reasons projects go over budget is that construction begins before the design is sufficiently developed.

Common Mistakes to Avoid When Hiring a Turnkey Partner

  • Going by price only: The low bidder may not include the same level of detailed engineering, which comes out later as change orders.
  • Not checking dosage-form experience: A company that’s strong in tablets may struggle in sterile rooms.
  • Skipping CQV planning until construction is done: CQV must be in on the design discussion from the beginning.
  • Not reviewing earlier projects: Photos and case studies do not tell you how a facility actually works.

A short list like this can save you months of rework once you get into the contract negotiations with a pharma turnkey consultancy firm.

Wrapping Up

Pharma turnkey consultancy services are designed to take the headache of coordinating the construction of a compliant, working facility from scratch. You have one team that is responsible for the agreed design, construction and CQV scope, which can mean better-controlled timelines, greater budget visibility and fewer late-stage surprises before inspection. That combination of engineering depth and hands-on project delivery can look like companies such as Pharma Access. The questions to ask are the same if you go with a big firm or a smaller specialist. What have they built before? Who owns the schedule, and how early does validation planning start?

Frequently Asked Questions

What is the difference between a turnkey consultant and a regular engineering firm?

A design-only engineering company only designs, so you have to hire separate contractors for construction and validation. A turnkey consultant takes design, procurement, construction, and CQV and bundles them into a single contract, with one team responsible for agreed facility-project scope.

How long does a typical pharma turnkey project take?

Timelines depend on the type and size of facility, but a small to mid-size  oral solid dosage plant may take approximately  18 to 24 months from design to handover. Sterile or biotech facilities usually take longer due to additional cleanroom and validation requirements.These timelines are indicative and can vary depending on project scope, site conditions, regulatory requirements, approval timelines and equipment lead times.

Do turnkey consultants handle FDA and WHO compliance documentation?

Most experienced companies includeGMP and qualification requirements design, such as cleanroom classification, airflow studies, and facility, utility and equipment qualification documentation, to support compliance with FDA CGMP requirements as well as WHO good manufacturing practice guidance. However, the manufacturer remains responsible for its pharmaceutical quality system, batch documentation, process validation, regulatory submissions and ongoing GMP compliance.

Is a turnkey model more expensive than hiring separate contractors?

Not necessarily. It might seem that the initial quote is higher, but one accountable contract tends to mitigate the change orders and delays that drive up costs with multiple vendors.

Can a turnkey consultant work on an existing facility, not just a new build?

Yup. Many companies perform brownfield expansions and upgrades within existing facilities, applying the same design-build-validate approach to adding capacity or new product lines without shutting down existing operations.

Top Pharma Turnkey Company in Andheri West, Mumbai

Top Pharma Turnkey Company in Andheri West Mumbai

Mumbai’s pharmaceutical sector is one of the most active in the country. And within Mumbai, Andheri West has quietly become a preferred address for pharma consultancy and engineering firms. If you are planning to set up or expand a pharmaceutical facility, finding the right pharma turnkey company in Andheri West can save you months of coordination and a great deal of money.

This post explains what pharma turnkey projects services actually cover, why Andheri West works as a base for these companies, and what you should check before signing with any firm.

What Does a Pharma Turnkey Company Actually Do?

A pharma turnkey company takes responsibility for a project from start to finish. The client hands over the requirements, and the firm manages everything: engineering design, procurement, civil construction, equipment installation, and final validation.

Let’s break it down. A standard turnkey scope for a pharmaceutical facility covers:

  • Engineering design: Process flow development, cleanroom classification, HVAC system design, MEP (mechanical, electrical, plumbing), piping, waste management, and automation.
  • Procurement and supply: Sourcing process equipment and machinery that meet cGMP standards.
  • Construction and installation: Civil, structural, and architectural work along with modular cleanroom build-outs.
  • Commissioning, Qualification, and Validation (CQV): Testing and documenting that every system performs as intended before a drug product is manufactured.
  • Project management: Scheduling, budgeting, vendor coordination, and regulatory documentation.

When a firm offers all of these under one roof, the client avoids coordination gaps between multiple contractors when challenges arise during project execution. The turnkey model puts accountability in one place.

Why Andheri West Works for Pharma Turnkey Firms

Andheri West is not a random choice. Here is why the location makes practical sense for a pharma turnkey company in Mumbai.

  • Connectivity to pharma manufacturing clusters: Maharashtra’s major pharma production zones, including those in Navi Mumbai, Taloja, Ambernath, and Badlapur, fall within a 45 to 90-minute drive of Andheri West. Project teams can reach sites without losing half a day to commute.
  • Access to talent: Mumbai has a large pool of pharmaceutical engineers, cGMP compliance professionals, and project managers. Andheri West’s position near the Western Express Highway and its metro connectivity makes it easier for firms to attract and retain qualified staff.
  • Airport proximity: Chhatrapati Shivaji Maharaj International Airport sits adjacent to Andheri. For firms running projects in the MENA region, Southeast Asia, or other international markets, this matters every week. Engineers and project leads can fly out and return without losing two days to travel logistics.
  • Vendor and supplier ecosystem: Andheri and its neighbouring areas in western Mumbai host a large number of industrial equipment suppliers and specialised contractors. A turnkey firm operating from here can hold supplier meetings, inspect samples, and finalise contracts without extensive travel.
  • Regulatory access: Key government and regulatory offices, including those linked to the Central Drugs Standard Control Organisation (CDSCO), are reachable from Mumbai. Being in the city puts a firm closer to the regulatory conversation.

What Services Should a Good Pharma Turnkey Company Offer?

Not every firm that calls itself a pharma turnkey company delivers the same scope. Here is what a genuinely full-service firm should cover.

Engineering Design for Diverse Dosage Forms

Engineering Design for Diverse Dosage Forms

The engineering work should go beyond generic cleanroom drawings. A capable firm should design facilities for:

  • Oral solid dosage (OSD): tablets, capsules, sachets, effervescent and extended-release formats
  • Sterile manufacturing: injectables including LVP, SVP, vials, ampoules, pre-filled syringes, and lyophilised products
  • Oral liquid dosage: syrups, suspensions, emulsions
  • Biotechnology: monoclonal antibodies, vaccines, cell and gene therapy, peptides, insulin
  • Active pharmaceutical ingredients (API): covering biological routes, chemical routes, oncology, and cephalosporins

Each dosage form has a different contamination risk profile, and the facility design, HVAC classification, and pressure differentials must match those risks. A firm that has actually built different types of facilities brings a different calibre of thinking to the design table.

Regulatory Compliance Built into the Design

GMP compliance is not something you bolt on at the end. It needs to be baked into every design decision: room finishes, air change rates, material flow, personnel flow, drain placement. A firm that builds facilities for GMP-regulated environments should be familiar with WHO GMP guidelines, US FDA cGMP requirements (21 CFR Parts 210 and 211), EU GMP Guidelines, including Annex 1 where applicable, and the Revised Schedule M requirements under the Drugs and Cosmetics Rules.

The Drugs and Cosmetics Act, 1940, along with the Drugs and Cosmetics Rules and subsequent amendments, governs pharmaceutical manufacturing in India. The Revised Schedule M prescribes the Good Manufacturing Practices (GMP) requirements that pharmaceutical manufacturers are expected to follow. Any pharma turnkey firm working in India should have a thorough understanding of these regulatory requirements.

Commissioning, Qualification, and Validation (CQV)

Commissioning, Qualification, and Validation (CQV)

CQV is where a lot of turnkey projects go soft. Design and construction can look fine on paper, but if the firm cannot qualify the HVAC system, validate the water system, or complete the equipment qualification documentation to a regulatory standard, the client ends up hiring another consultant to fix it. A proper pharma turnkey company in Andheri West should have in-house CQV capability, not just engineering teams.

Modular and Prefabricated Facility Options

Conventional construction takes time. Modular construction, where sections of the facility are prefabricated off-site and assembled on location, cuts project timelines and reduces on-site risk. Some firms have developed proprietary modular facility concepts that allow faster installation with consistent quality.

Project Management Across Geographies

A pharma turnkey firm with a strong track record will have completed projects outside India. This matters because it signals that the firm can manage international vendor relationships, deal with customs and logistics, and coordinate multilingual teams on site.

Critical Utility Systems

In addition to process equipment and facility construction, a pharmaceutical turnkey project should include the engineering and integration of critical clean utility systems, including Purified Water (PW), Water for Injection (WFI), Clean Steam, Compressed Air, HVAC, Building Management Systems (BMS), and Electrical & Utility Distribution Networks. These systems are essential for maintaining GMP compliance, supporting reliable manufacturing operations, and ensuring consistent product quality throughout the facility lifecycle.

Pharma Access: A Pharma Turnkey Company in Andheri West

Pharma Access is headquartered at 702, Supreme Chambers, Veera Desai Road, Andheri West, Mumbai 400053. The firm has been in pharma turnkey consulting since 2001 and has delivered over 120 projects across more than 18 countries.

Their scope spans engineering design, procurement and supply, civil construction, CQV, and project management. The firm covers all major dosage forms including biotechnology, sterile manufacturing, OSD, oral liquid dosage, and API facilities.

Pharma Access holds ISO 9001:2015 (Quality Management Systems), ISO 14001:2015 (Environmental Management Systems), and ISO 45001:2018 (Occupational Health and Safety) certifications. internationally recognised management system certifications that reflect the company’s commitment to quality, environmental responsibility, and workplace safety.

Pharma Access combines multidisciplinary engineering expertise with structured project management capabilities to support pharmaceutical projects across diverse dosage forms and regulatory environments. Their team includes over 70 engineering personnel, 12 discipline subject matter specialists, and 8 technical project managers. They also developed a Modular Mobile Facility (MMF) concept, which applies prefabricated construction to pharmaceutical environments for faster project delivery.

Clients include Dr. Reddy’s, Piramal, Aragen, Al Shifa, and projects in Algeria, Saudi Arabia, Egypt, Syria, and the Middle East.

This level of scale and geographic spread is worth mentioning because it tells you the firm has managed regulatory differences, logistics complexity, and technical challenges across different markets.

How to Evaluate a Pharma Turnkey Company Before You Hire One

Next steps matter once you start comparing firms. Here is a practical checklist.

1. Ask for project references in your specific dosage category: A firm that has done 50 OSD plants but never handled a sterile injectable facility is not the right partner for your injectables project. Ask specifically.

2. Check the CQV capability: Request their standard CQV plan and ask who on the team holds the relevant qualifications. If they plan to subcontract the validation work, find out who to and what their quality standards look like.

3. Review their regulatory track record: Have they built facilities that successfully passed WHO inspections, USFDA audits, or EU GMP assessments? Ask for documented outcomes, not just claims.

4. Understand their project management method: A firm running multiple projects simultaneously needs a structured project management system. Ask how they track schedule, budget, and change orders across active projects.

5. Visit a completed facility if possible: Nothing replaces a site visit. Ask the firm to arrange a walk-through of a recently completed project. A completed facility often provides better insight into engineering quality, workmanship, and project execution than any proposal or presentation.

6. Confirm their ISO certifications are current: ISO 9001, 14001, and 45001 certifications are independently audited. Ask for the current certificate and verify the issuing body.

Andheri West vs Other Mumbai Locations for Pharma Consultancy

Some pharma turnkey firms operate from Lower Parel, BKC, or Navi Mumbai. Each has trade-offs.

BKC and Lower Parel are closer to corporate headquarters and banking, but they sit further from industrial corridors. Navi Mumbai is close to manufacturing zones like Taloja and Mahape but can be harder for international travel.

Andheri West balances proximity to the airport, access to western and central industrial corridors, and availability of technical talent from nearby residential areas like Goregaon, Malad, and Borivali. For a firm running international pharma projects, this combination works better than a purely corporate address.

Frequently Asked Questions

1. What is a pharma turnkey company, and what does it include?

A pharma turnkey company manages the complete delivery of a pharmaceutical facility, covering design, procurement, construction, equipment installation, and validation. The client hands over the project brief, and the firm is accountable for delivering a ready-to-operate facility.

2. Why should I choose a pharma turnkey company in Andheri West specifically?

Andheri West offers direct access to Mumbai airport, strong connectivity to Maharashtra’s pharma manufacturing clusters, a large pool of qualified engineers, and proximity to key suppliers and regulatory offices. These factors make it a practical base for firms running both domestic and international projects.

3. What regulatory standards should a pharma turnkey firm be familiar with in India?

Any firm working on Indian pharmaceutical projects should understand Revised Schedule M requirements of the Drugs and Cosmetics Act, WHO GMP guidelines, and CDSCO requirements. For export-oriented facilities, US FDA 21 CFR Parts 210 and 211 and EU GMP Guidelines, including Annex 1 where applicable, needed.

4. How long does a pharma turnkey project typically take from design to validation?

Project timelines depend on the type of facility. A greenfield oral solid dosage plant may take 18 to 30 months. A sterile or biotech facility often takes longer, ranging from 24 to 48 months, because of the stricter design requirements, cleanroom classifications, and validation workload.

5. What is the difference between an EPC contractor and a pharma turnkey consultant?

An EPC (Engineering, Procurement, and Construction) contractor covers design, sourcing, and building. A pharma turnkey consultant may also include CQV, regulatory documentation support, and GMP-specific engineering that goes beyond standard civil and MEP work. The pharma-specific layer, including cleanroom design, HVAC validation, and process equipment qualification, is what separates a general EPC firm from a dedicated pharma turnkey company.

How Mobile Racking Systems Improve Efficiency in Pharma Warehouses

How Mobile Racking Systems Improve Efficiency in Pharma Warehouses

A pharmaceutical warehouse is not a storage room. It includes active ingredients, finished drug products, and temperature-sensitive biologics that have a direct effect on patient safety. Every square meter, every access point, every storage decision, is regulatory weight.

This is where mobile racking systems come in handy. These are some of the most practical ways pharmaceutical facilities can get more out of their existing warehouse footprint while remaining aligned with Good Manufacturing Practice (GMP) compliance and Good Distribution Practice (GDP) requirements.

Let’s break it down.

What Are Mobile Racking Systems?

A mobile racking system is a storage system in which shelving units or pallet racks are mounted on motorized or mechanical carriages that move on rails mounted on the floor. Rather than having multiple permanent aisles running between static rows of racking, the whole bank of racks moves to create a single access aisle wherever the operator needs it.

If a worker needs to retrieve goods from a specific row, the adjacent rack units slide apart on their rails, creating an aisle on demand. Most systems open an aisle in 10-20 seconds. Control options range from simple push-button panels to integration with warehouse management systems (WMS).

This design eliminates the dead space that static racking provides. A typical warehouse can use up 50 to 60 percent of its floor space in aisle space alone without storing a single pallet. Mobile racking takes back that space.

Why Pharma Warehouses Have Unique Storage Demands

To understand what mobile racking systems can do, it is useful to know what makes pharmaceutical warehouse storage different from general industrial storage.

The challenge is that Pharmaceutical warehouses are subject to GMP and GDP rules that encompass everything from temperature control and humidity to product segregation, traceability, pest control, and documentation. The World Health Organization’s GDP guidance and the EU’s Good Distribution Practice requirements both require that medicines be stored under controlled conditions throughout the supply chain to ensure their safety and efficacy.

Which in practice means:

  • Clearly separated storage areas for quarantined, released, returned, and rejected materials
  • Cold chain conditions in temperature-controlled areas (typically +2 to +8°C for biologics and vaccines and +15 to +25°C for ambient pharmaceuticals)
  • FEFO inventory rotation (First Expired First Out) to prevent expired stock from entering the distribution chain
  • Real-time inventory traceability and accurate batch documentation
  • Storage area and racking structure cleaning and housekeeping records
  • Monitoring of humidity and temperature with validated equipment and documented deviations

Static shelving and fixed pallet racking can satisfy some of these needs, but they are much less space efficient and difficult to reconfigure as regulations or product lines change. Mobile racking eliminates both problems.

How Mobile Racking Systems Improve Pharma Warehouse Efficiency

1. Significant Space Gains Without New Construction

Significant Space Gains Without New Construction

The most direct benefit is the increase in storage density. The mobile racking system can significantly increase storage density compared with conventional static racking systems, depending on the facility layout and operational requirements. Some systems remove unused aisles, increasing usable storage capacity by 50 percent or more.

This is a direct financial benefit for pharmaceutical manufacturers in urban locations, leased facilities, or temperature-controlled cold rooms where every cubic meter costs significant energy and construction. Building more warehouse space is expensive and takes a lot of time. In many facilities, expanding the building footprint is not feasible, making storage optimization within the existing envelope a more practical solution.

This is particularly true for cold storage areas. Cold rooms are some of the most expensive real estate in a pharma facility to build and operate. You can get more out of that envelope without expanding it, cutting capital and operating costs.

2. Support for FEFO and FIFO Inventory Management

GMP requires pharmaceutical warehouses to manage the flow of products in and out of storage. FEFO (First Expired, First Out) and FIFO (First In, First Out) principles are applied to ensure that the products do not stay in the storage beyond their expiry date, which is a regulatory non-compliance and patient safety issue.

Mobile racking systems support these practices by providing individual access to each row. With drive-in racking, the pallets are stored in deep aisles with only the front pallet being accessible, whereas with mobile systems, the operator can open up any aisle and access any row whenever they want. This means the warehouse team can pick stock by batch number and expiry date, without needing to work around blocked lanes or physically move pallets.

Mobile racking, when used with a warehouse management system (WMS) that tracks batch numbers and expiry dates in real time, makes FEFO compliance a practical and repeatable process, rather than a manual exercise with room for error.

3. Product Segregation and Contamination Control

The different product statuses in a warehouse need to be physically separated clearly in line with GDP guidelines. Quarantined goods should not be mixed with released stock. Dedicated and clearly identifiable storage areas are required for rejected, returned, and recalled products. Temperature-sensitive and ambient products need to be zoned.

Mobile racking systems can aid in this in a confined floor space. Color coding or lockable mobile system sections can be used to give visual cues for product status areas. Different product categories can be assigned to different carriages. The physical separation is maintained regardless of how the racks move in the course of the access operations.

For high-hygiene pharmaceutical environments, stainless steel construction may be selected due to its cleanability, corrosion resistance, and compatibility with GMP cleaning procedures. It is non-reactive, non-porous, and resistant to cleaning agents routinely used in GMP areas, allowing for easy documentation of maintenance and cleaning validation.

4. Temperature Zone Efficiency in Cold Storage

 Temperature Zone Efficiency in Cold Storage

Cold chain pharmaceutical products (vaccines, biologics, insulin, and associated products) need to be maintained at +2 to +8°C and kept there uninterrupted. Any excursions that are out of range will be subject to documented investigation and may result in batch rejection or recall.

Mobile racking systems are ideal for cold room and freezer environments with configurations rated for operation down to -20°C. The system reduces non-productive storage space within the cold room by minimizing permanent aisles, allowing better utilization of the refrigerated volume. Lower air volumes to condition imply better temperature distribution and less energy consumption by refrigeration equipment.

WHO GDP guidelines require cold storage areas to have backup power systems, temperature mapping that has been validated, and continuous monitoring with documented deviation responses. When properly designed and qualified, a mobile racking system can support more efficient airflow management and temperature distribution within cold storage environments, helping maintain compliance during temperature mapping and qualification activities.

5. Adaptability for Pharma Manufacturing Automation

Adaptability for Pharma Manufacturing Automation

The pharmaceutical industry is moving toward more pharma manufacturing automation in production and warehouse operations. Mobile racking systems are a natural fit for this direction, since they are designed to integrate with modern warehouse management tools.

Push-button controls, barcode-triggered aisle opening, and WMS integrations all allow the racking system to function within an automated or semi-automated warehouse without the full investment of an automated storage and retrieval system (AS/RS). For companies still operating at mid-scale, this is a practical middle ground between fully manual static storage and high-capital robotic systems.

With the growth of operations, mobile racking can be further expanded by increasing the number of carriage units, changing the rail configurations, or adding additional shelving levels without dismantling the core structure. This modular cleanrooms pharmacy design enables the facility to adapt to changing product portfolios and regulatory requirements over time.

Pharma Equipment and Manufacturing Process Design: Where Storage Fits

Warehouse design is often an afterthought in the planning of pharmaceutical facilities. The movement of raw materials, intermediates, and finished goods through the warehouse actually has a direct impact on production scheduling, batch traceability, and GMP audit readiness.

That is why when pharma equipment and manufacturing process design are done properly, warehouse layout is part of the engineering scope, not a separate procurement decision after the manufacturing areas are built. Facility design from the beginning must include racking type, aisle widths, zone designations, cleaning access, and temperature mapping points.

“Warehouse and storage design is an integrated part of the facility engineering scope,” says Pharma Access, which has over 25+ years of experience working on more than 100 pharmaceutical projects in the biotech, sterile, OSD, and API facility categories. Their end-to-end services include engineering design, procurement of pharmaceutical equipment and manufacturing infrastructure, construction and installation, and CQV (commissioning, qualification, and validation). When rack decisions are made in this broader context, the storage system meets the facility’s regulatory and operational requirements from day one, rather than being retrofitted later.

Validation and Qualification Considerations

Mobile racking systems installed in GMP-regulated facilities should be included within the overall facility qualification strategy. Depending on the warehouse classification and intended use, qualification activities may include installation verification, load testing, operational checks, cleaning procedures, maintenance requirements, and integration verification with warehouse management systems (WMS).

Proper documentation of the racking system, including load ratings, maintenance procedures, cleaning records, and qualification reports, helps support inspection readiness and long-term regulatory compliance. Incorporating these considerations during the facility design phase can reduce qualification challenges and support smoother project execution.

Considerations Before Choosing a Mobile Racking System

Considerations Before Choosing a Mobile Racking System

Mobile racking is not a must for every pharmaceutical warehouse. Here’s an easy way to figure out if it makes sense for a given facility:

Mobile racking is a great fit when:

  • Inventory volume exceeds floor space available
  • Cold room or freezer space is costly to build and operate
  • Several product categories require separate storage areas
  • FEFO compliance is hard to manage with the current static racking.
  • The facility wants to broaden its product portfolio without broadening floor space.
  • Static racking is suitable where:
  • Very high throughput. Need to access multiple aisles at the same time, all the time
  • Few SKUs are handled by the warehouse with simple rotation requirements
  • Budget considerations favor low initial capital costs

The structure of the floor also matters. Mobile racking passes concentrated loads via the carriage bases to the concrete floor. So, it is necessary to check the structural load capacity and floor levelness prior to installation. Fire suppression system layouts may also require modifications to maintain sprinkler coverage over mobile rack configurations, and should be reviewed in accordance with applicable local fire safety codes and insurance requirements..

The Role of Pharmaceutical Engineering Consultants in India

India is one of the largest exporters of finished pharmaceutical products and APIs in the world, with a plethora of facilities operating in regulatory jurisdictions like the US FDA, EU GMP, WHO, and CDSCO. In these facilities, storage and warehouse design must adhere to many overlapping sets of guidelines at the same time.

The practical advantage of this process is that there are pharmaceutical consultants in India who specialize in turnkey facility design, such as Pharma Access, based in Mumbai. They understand the local regulatory environment, have relationships with qualified equipment and racking vendors, and have documented experience with warehouse qualification to international inspection standards.

It is far more cost-effective for a manufacturer facing an EU GMP or WHO pre-qualification audit to have the warehouse racking and zone segregation design reviewed by an experienced consulting team before construction than to have to remediate after an inspection observation. Documentation packages for mobile racking must be included in the qualification file from day one and must contain load calculations, cleaning validation protocols, and GDP segregation zone maps.

Frequently Asked Questions

1. What is a mobile racking system, and how does it differ from static racking?

Mobile racking systems have shelving or pallet racks installed on motorized carriages running on rails on the floor. Aisles open on demand rather than remaining permanently available between every row. This leads to a dramatic increase in storage density, with some systems providing up to three times more pallet positions in the same floor space as static configurations.

2. Are mobile racking systems compliant with GMP and GDP warehouse requirements?

Yes, if properly specified. Mobile racking systems can be color-coded or lockable to meet GMP and GDP segregation requirements for products. Stainless steel options meet pharmaceutical surface cleanliness requirements. In addition, the facility design documentation shall address load capacity, floor strength, and fire suppression layout requirements for the system.

3. Can mobile racking systems be used in pharmaceutical cold rooms?

Yes. Mobile racking is very suitable for cold room and freezer applications, with some systems able to operate down to -20°C. Mobile racking reduces the unnecessary aisle air volume in the cold room, which contributes to a more uniform temperature distribution, thereby facilitating GDP temperature mapping and monitoring compliance.

4. How does mobile racking support FEFO inventory management in a pharma warehouse?

Mobile racking means that operators can open the required aisle on demand to access any row at any time. Unlike deep-lane drive-in racking, there is no need to move pallets to reach a particular batch number or expiry date. When using a warehouse management system that tracks expiry dates and batch numbers, FEFO rotation becomes a reliable and auditable process, rather than a manual workaround.

5. When should pharmaceutical companies involve consultants in warehouse racking decisions?

The sooner the better. The way you rack has implications for floor load calculations, fire suppression layouts, GDP zone segregation design, temperature mapping protocols, and the qualification documentation package. Having experienced pharmaceutical consultants in India or internationally involved during the facility engineering design stage and not post-construction avoids expensive design changes and helps to ensure that the storage system is inspection-ready from day one of operation.
